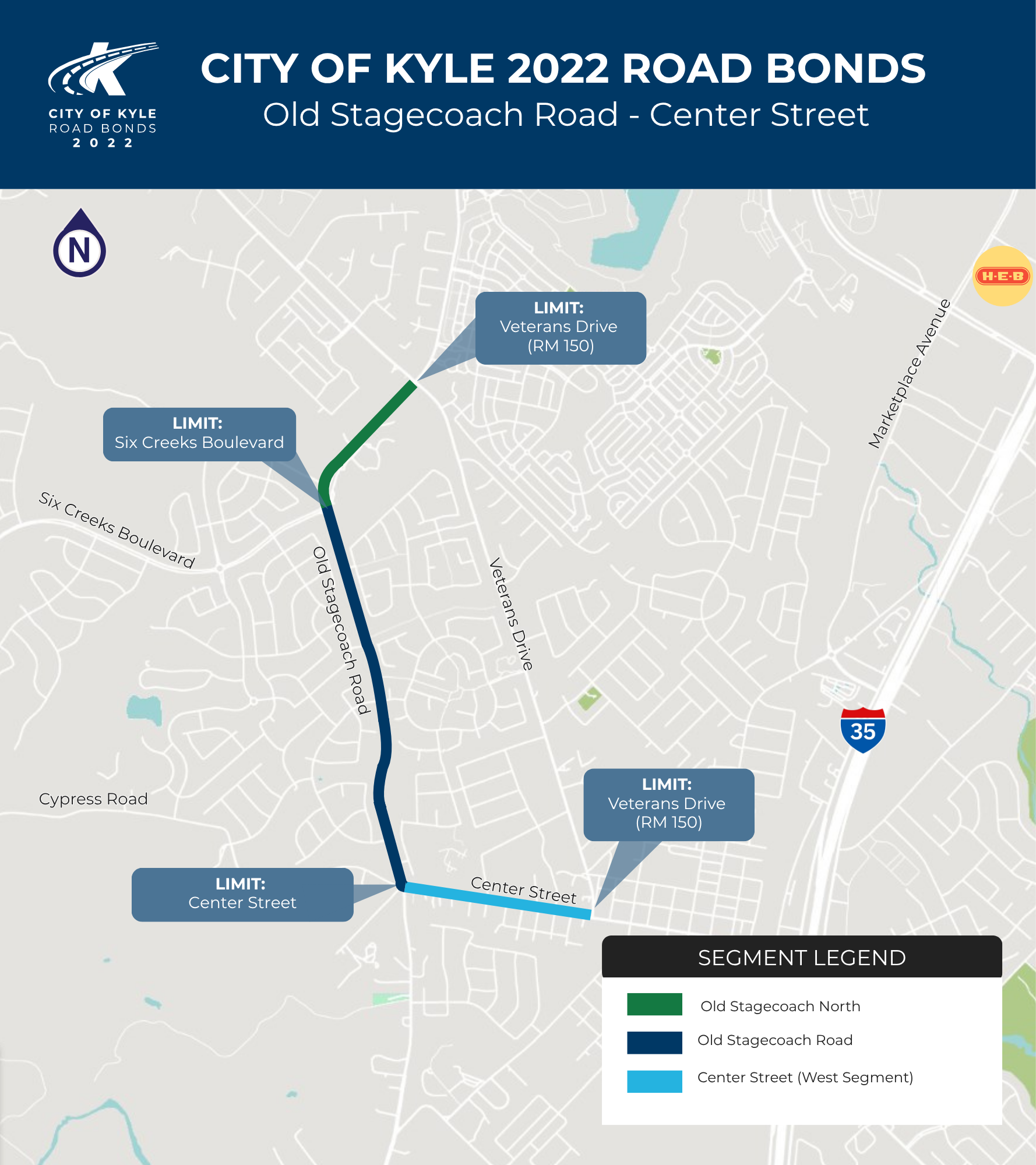

OLD STAGECOACH ROAD CENTER STREET

Limits: From Center Street to Veterans Drive via Old Stagecoach Road.
The City of Kyle is improving a 2.2-mile stretch of Old Stagecoach Road and Center Street to reduce congestion, enhance safety, and improve traffic flow. Funded by the 2022 Road Bond, the project will widen and reconstruct the roadway from Veterans Drive (RM 150) to Center Street, creating a continuous four-lane connection. Improvements include new roundabouts and capacity upgrades, with construction expected between Spring 2026 and Summer 2027.
Overview
Project Updates
October 2025
Design is 60% complete, with 90% PS&E, (Plans, Specifications, and Estimates) is a special package of detailed documents that engineers create before a road improvement project, is due November 14, 2025. Right-of-way offers are being distributed to property owners. Acquiring this land is essential for expanding the corridor and constructing the roundabout at Six Creeks.
-

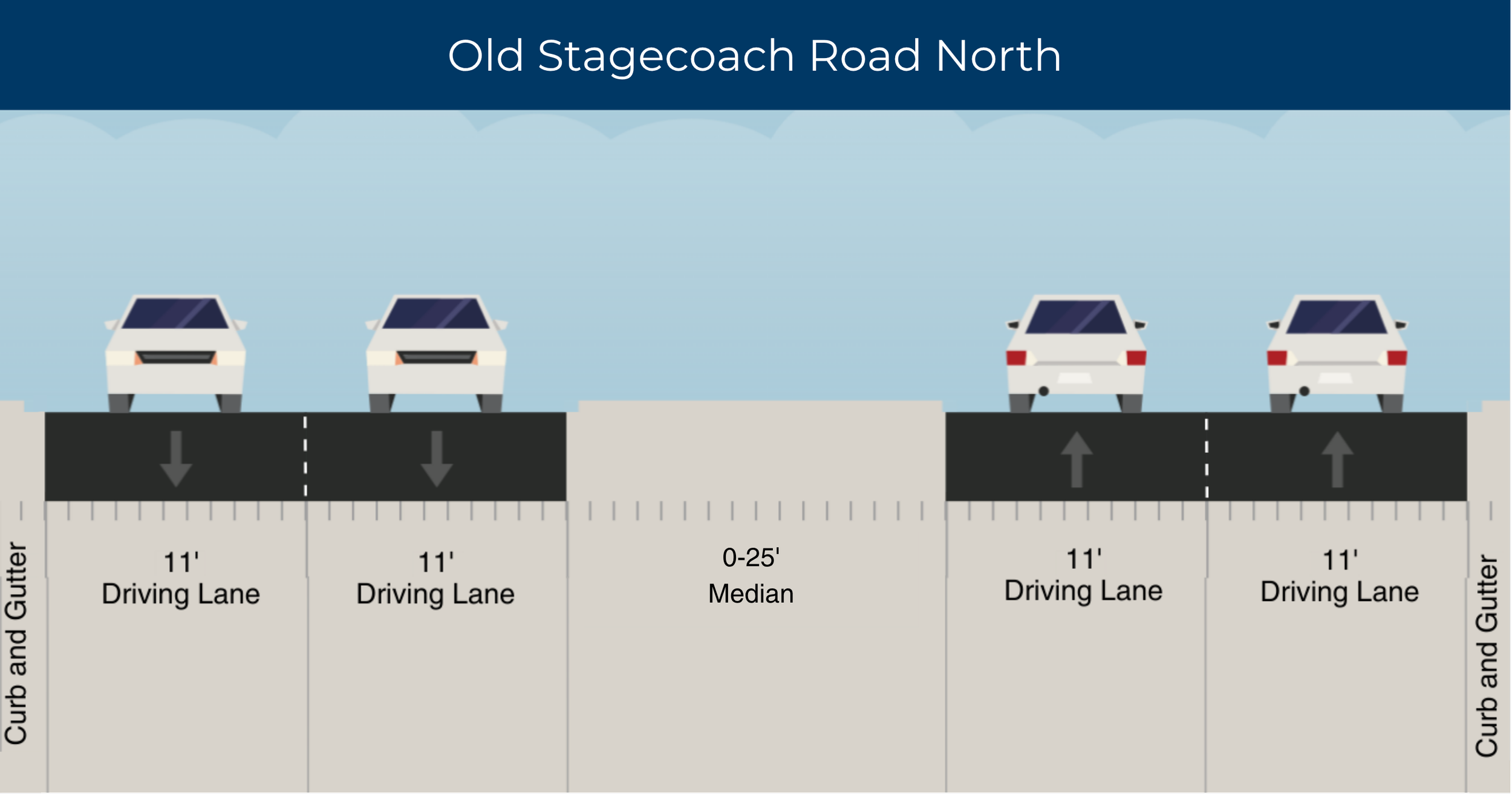

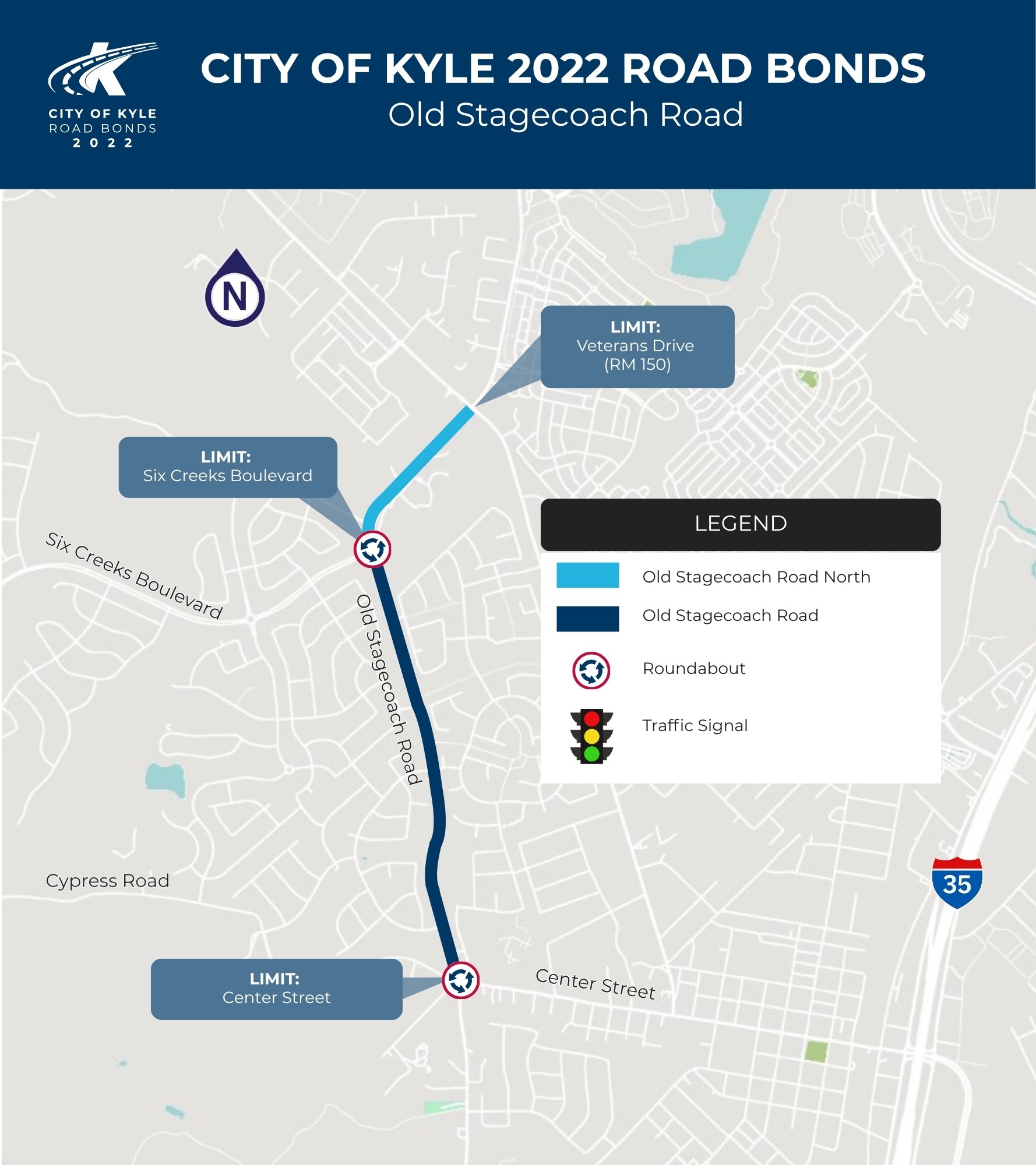

Old Stagecoach Road North
Length: 0.50 miles
Location: Veterans Drive to Six Creeks Boulevard

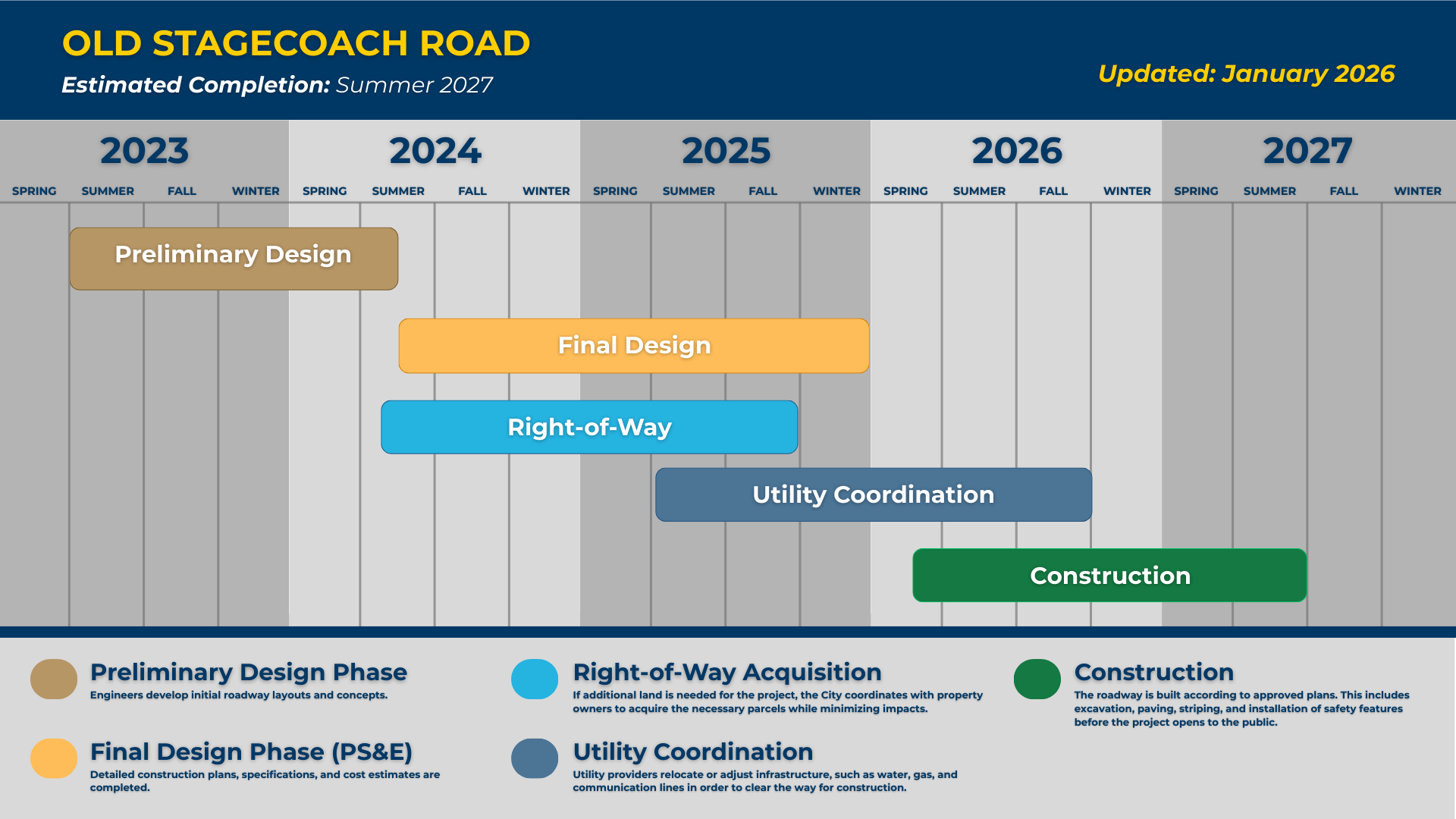

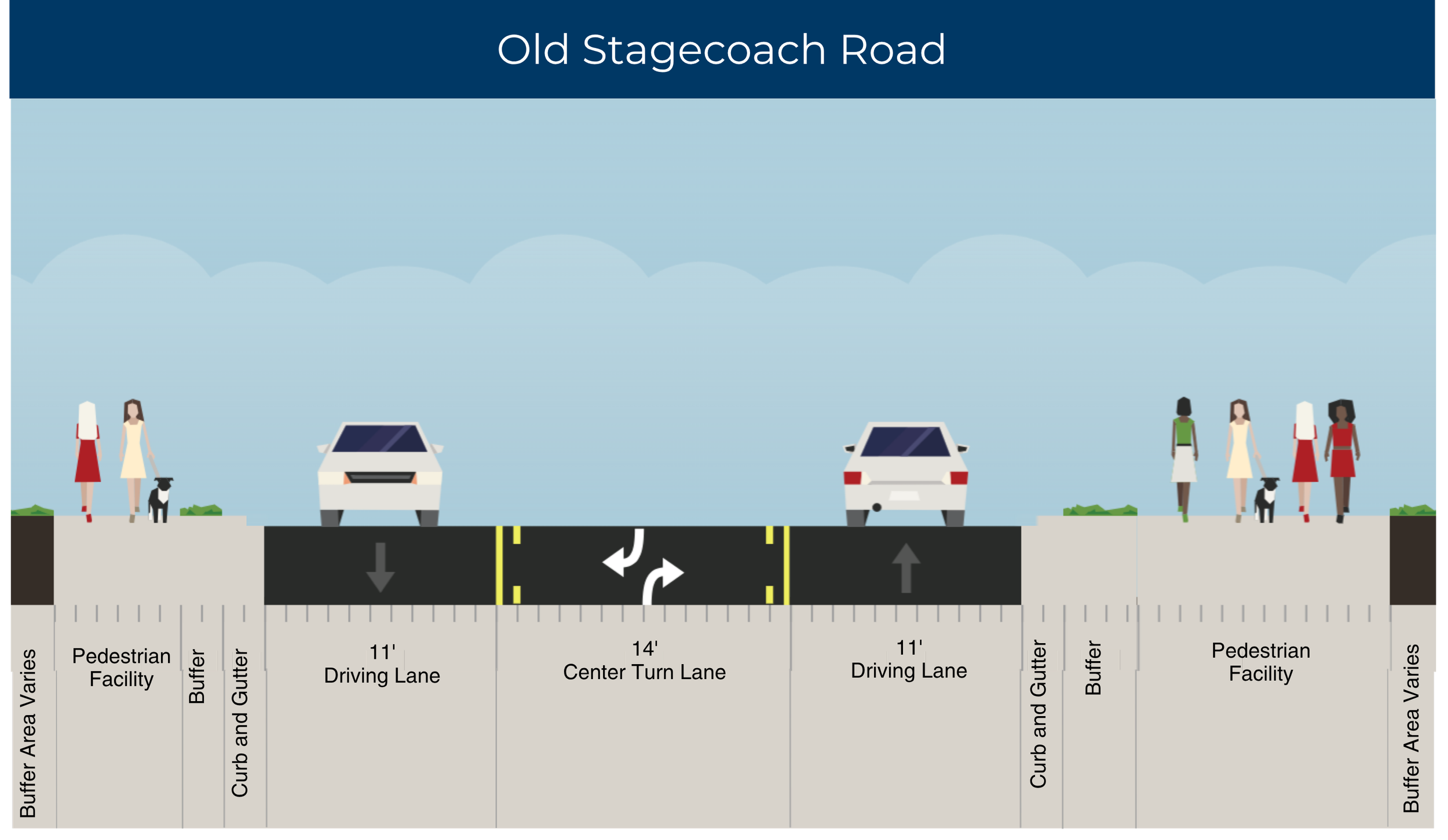

Old Stagecoach Road
Length: 1.02 miles
Location: Six Creeks Boulevard to Center Street

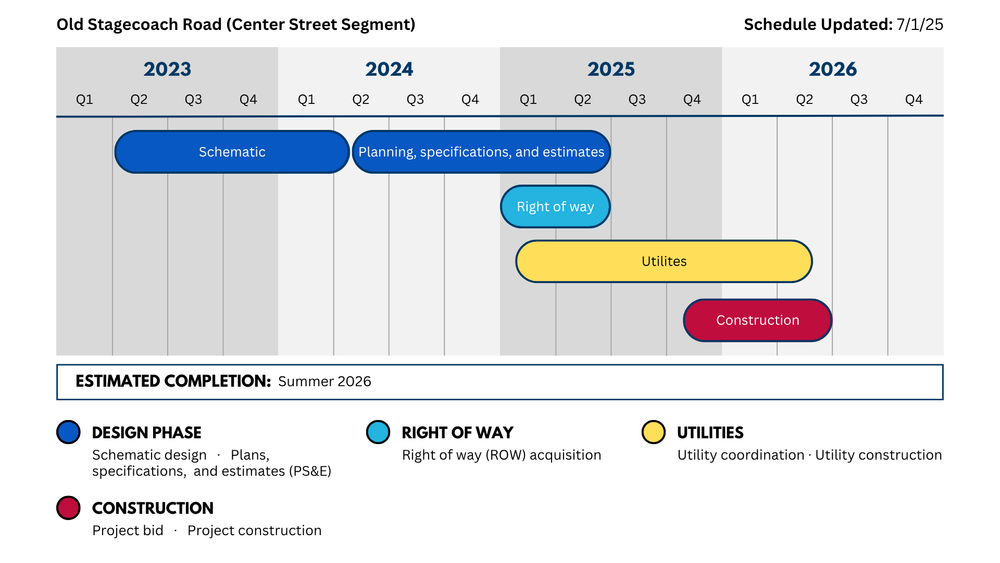

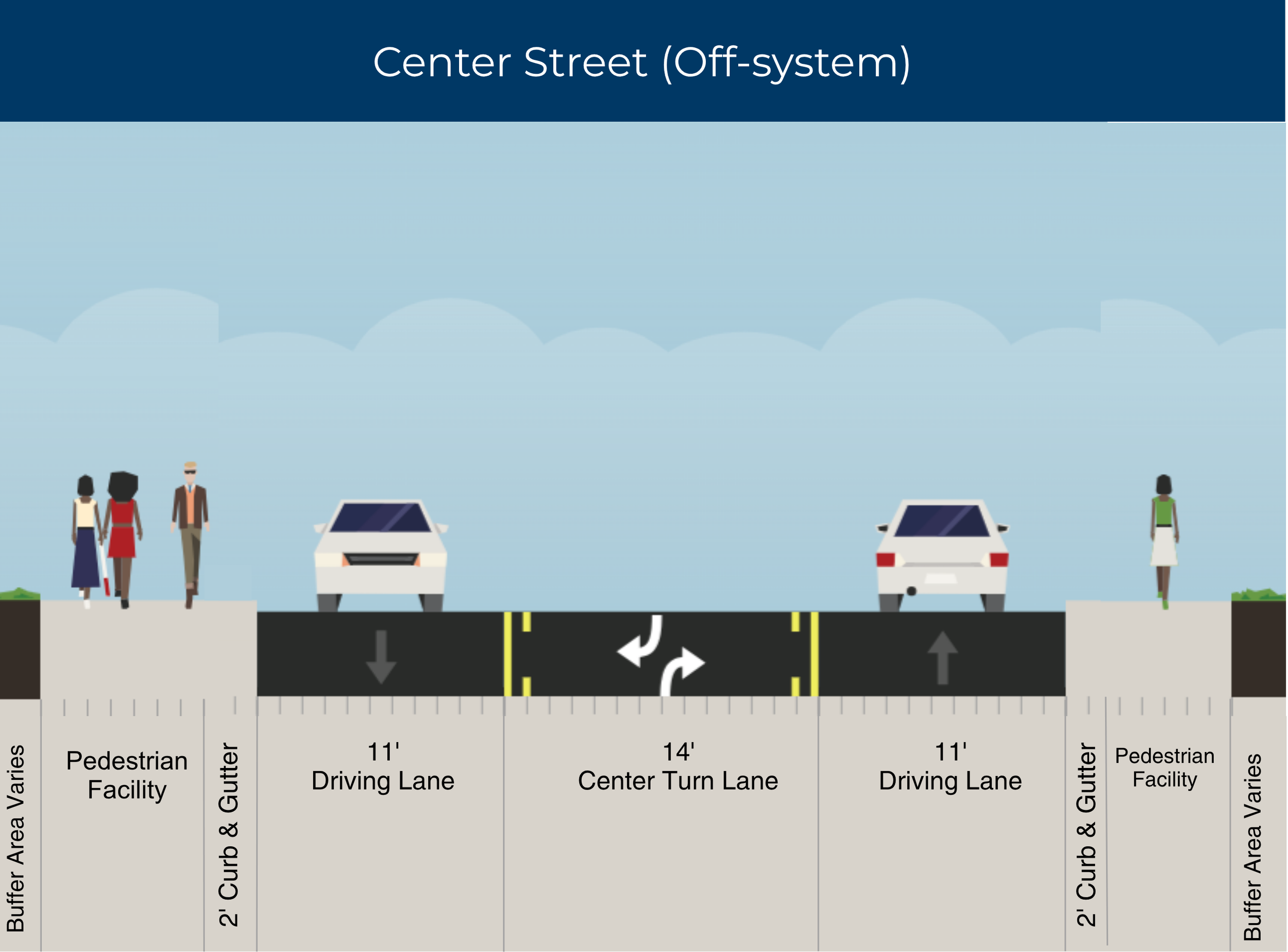

Center Street (West Segment)
Length: 0.62 miles
Location: Old Stagecoach Road to Veterans Drive
-

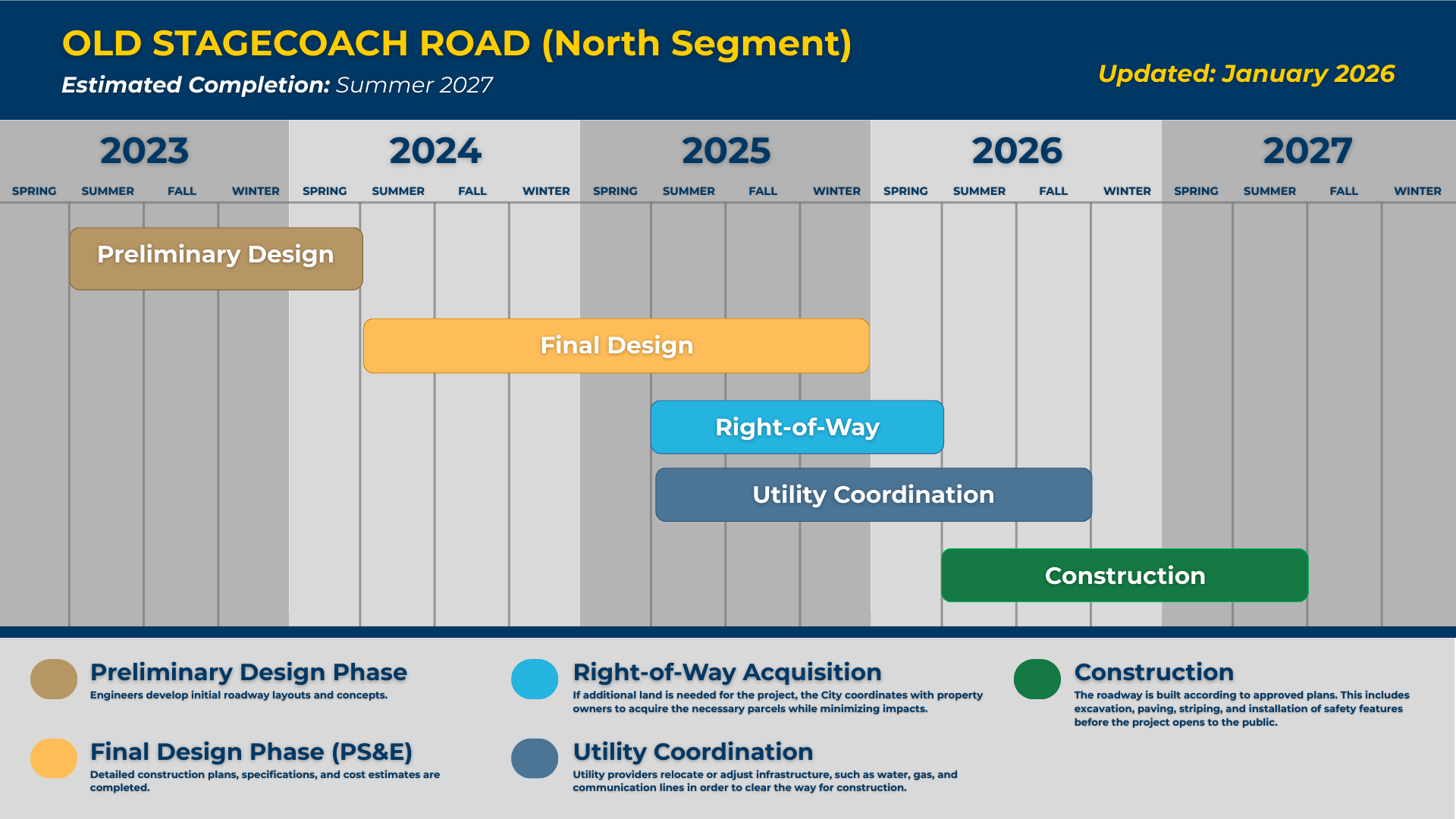

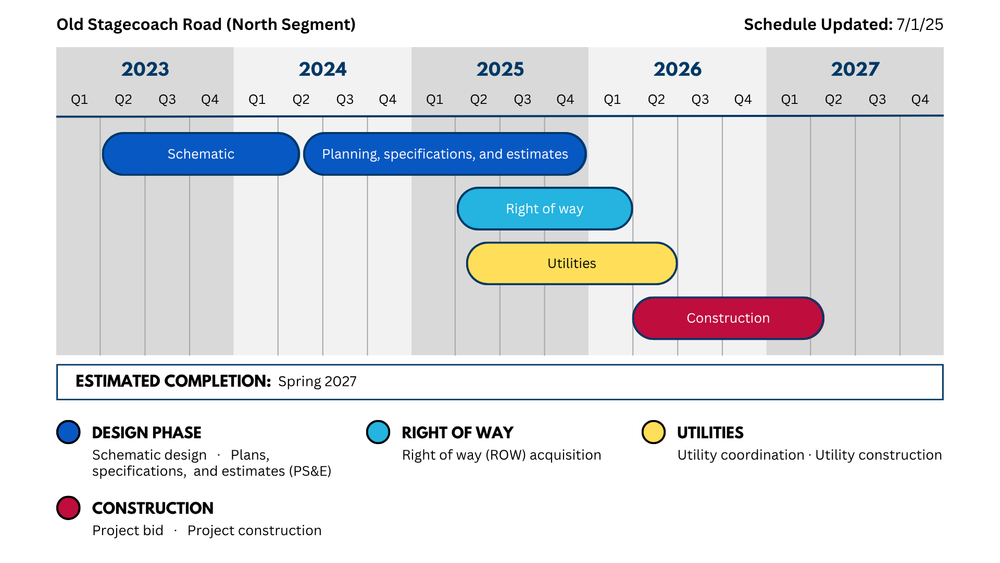

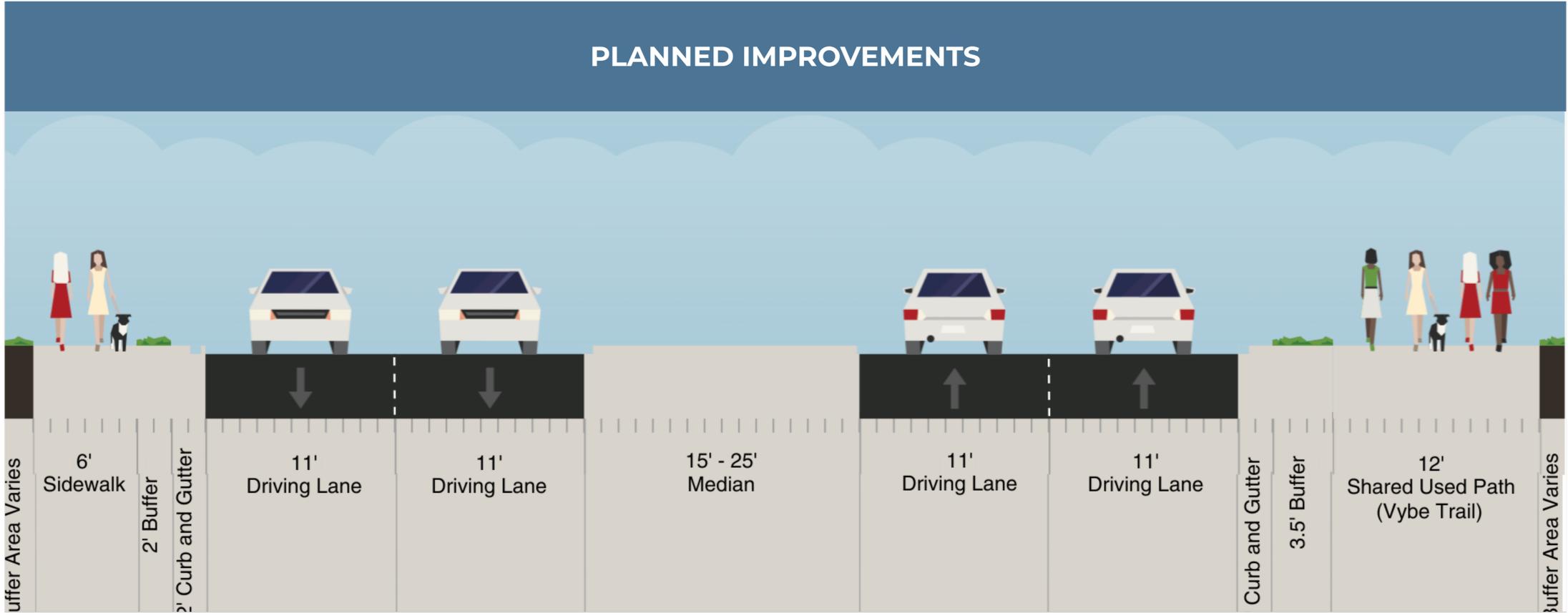

Old Stagecoach Road North
Roadway reconstruction and widening improvements
Old Stagecoach Road
Roadway reconstruction and widening improvements

Center Street (West Segment)

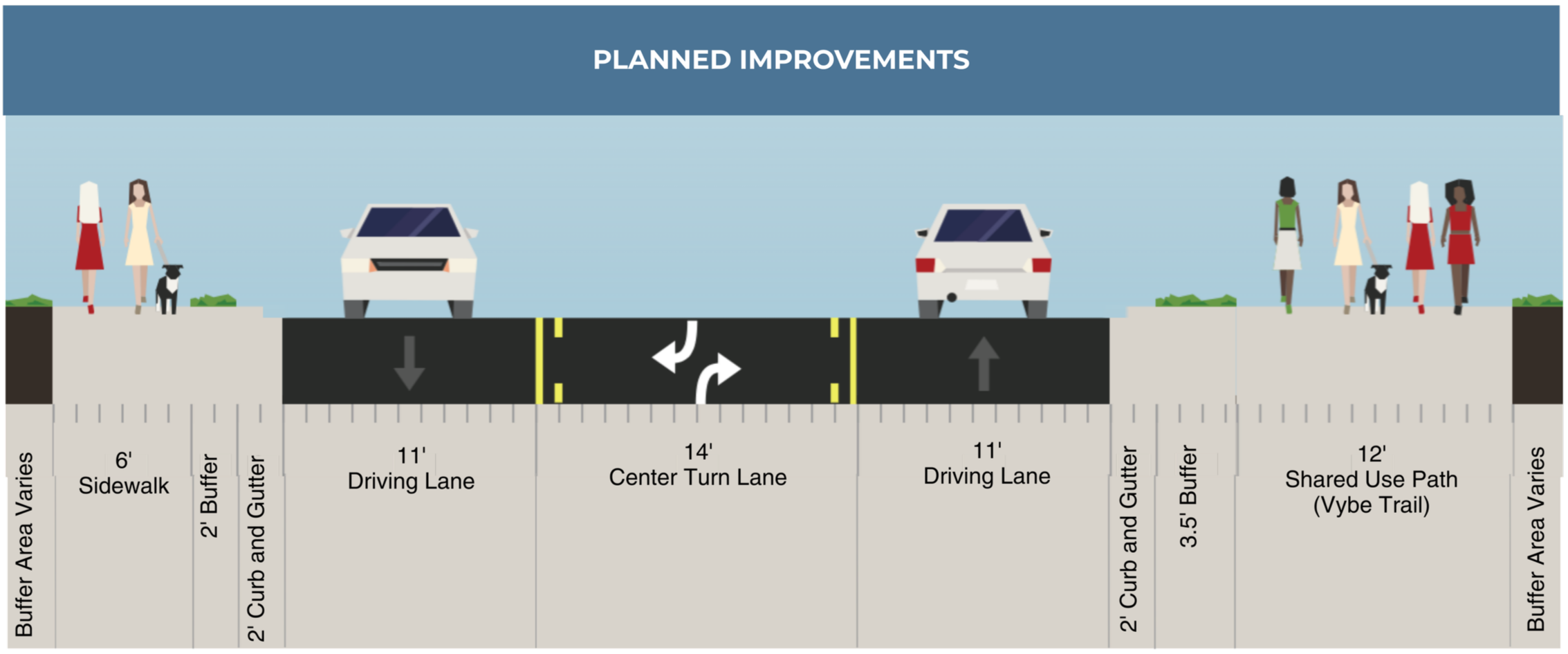

Expand the roadway footprint to one lane in each direction and add center turn lane
-
Construction funded by the City of Kyle’s 2022 Road Bond
Total Project Cost = $41.2 M
-
Design Phase: Preliminary design is currently in progress
Requests for Construction Proposals: Kyle City Council opted to bid this and the Center Street project independently to accelerate delivery, despite some temporary travel delays during construction
Construction is anticipated to begin in early 2026, anticipated completion in Fall 2027

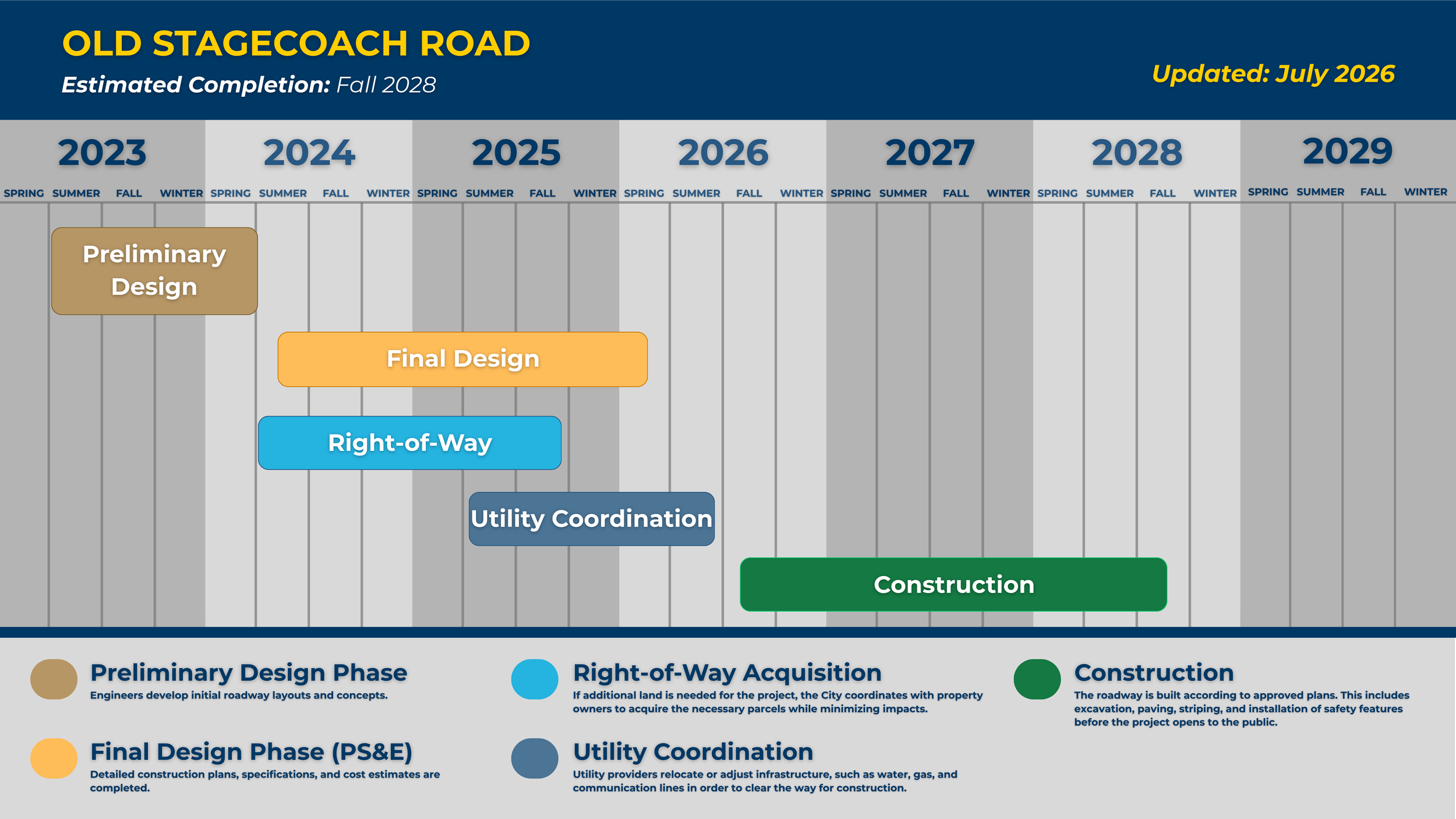

Schedule and Project Status
Project Resources
-
Click on the title below to view each item.
-
Click on the title below to view each item.
-
Click on the title below to view each item.
Old Stagecoach Road Fact Sheet Coming Soon
-
Click on the title below to view each item.
-
Looking for detailed information about the heritage Live Oak tree on Old Stagecoach Road?
Visit our dedicated Old Stagecoach Heritage Oak Tree page.
Previous Project Updates
Old Stagecoach Road Nears Final Design; Kyle Parkway/Lehman Extension Plans Completed
August 20, 2025
The Old Stagecoach Road project has reached 70% of its design phase, aiming to widen the corridor to four lanes and add roundabouts at Six Creeks and Center Street. Meanwhile, the design for the Kyle Parkway/Lehman Road Extension is now fully complete. This 1.3-mile extension will connect Bunton Creek Road to Dacy Lane with four lanes and four roundabouts, marking a major step forward in Kyle’s road improvements.
Progress Update: Bebee PS&E at 85%, Old Stagecoach Design 50% Done, Kyle Parkway Designs Due July 21
July 17, 2025
The City of Kyle is making steady progress on several road projects. Bebee Road East is 85% designed and will include three roundabouts to improve traffic flow. Old Stagecoach Road is halfway through design and will expand to four lanes with roundabouts at Six Creeks and Center Street. Final designs for the Kyle Parkway and Lehman Road Extension are expected by July 21, adding more connectivity and roundabouts to the area.
Get Your Questions Answered Virtually or In-Person at the 2022 Road Bond Open House
March 30, 2025
The City of Kyle is hosting a Road Bond Program Open House on Thursday, April 10 at City Hall (100 W. Center Street) beginning at 5:30 p.m. Residents can learn about eight road improvement projects approved in the 2022 bond, review project timelines and designs, ask questions of officials, and share feedback. There will be both a live-stream panel and in-person stations so everyone can participate.
