BEBEE ROAD

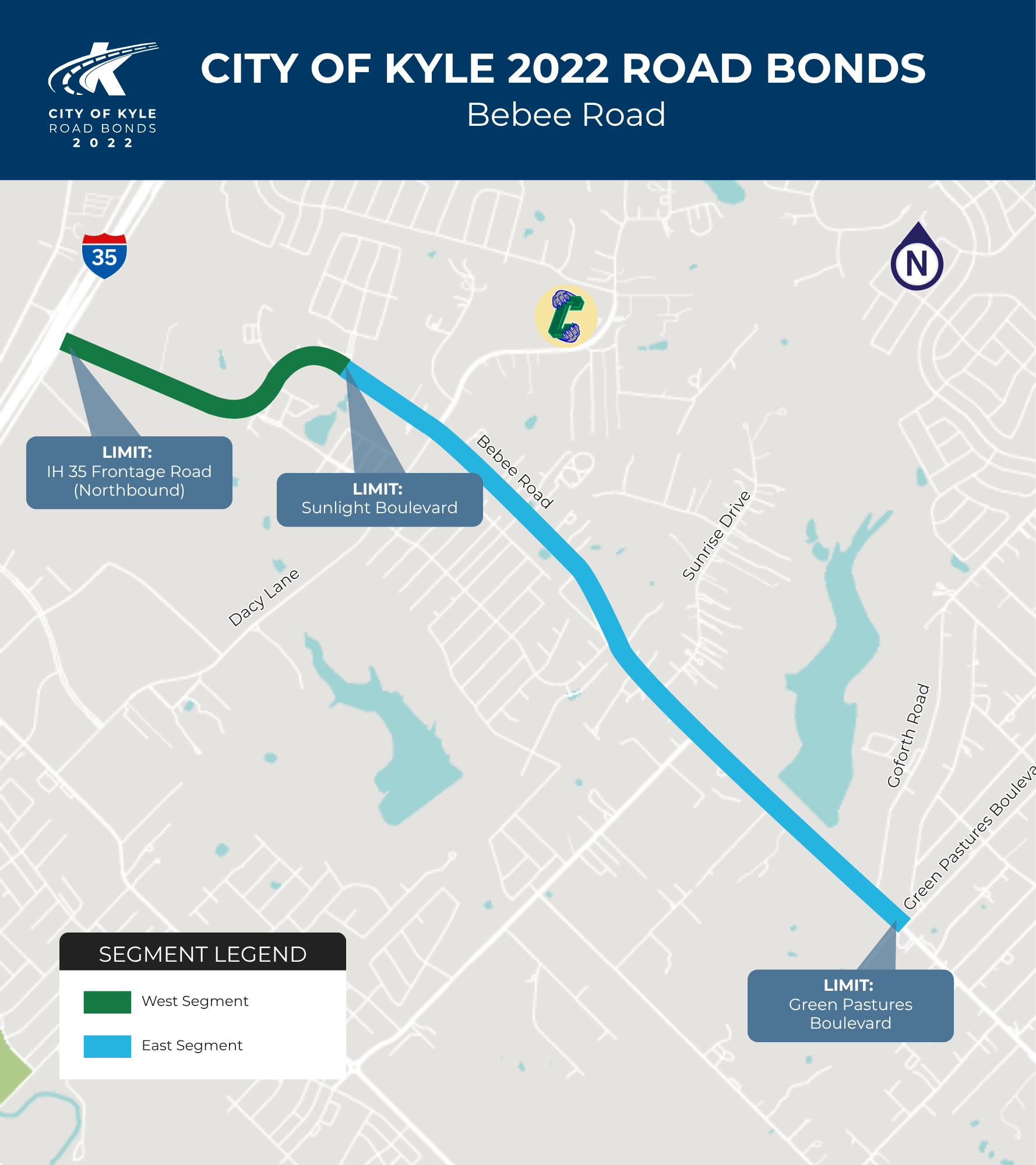

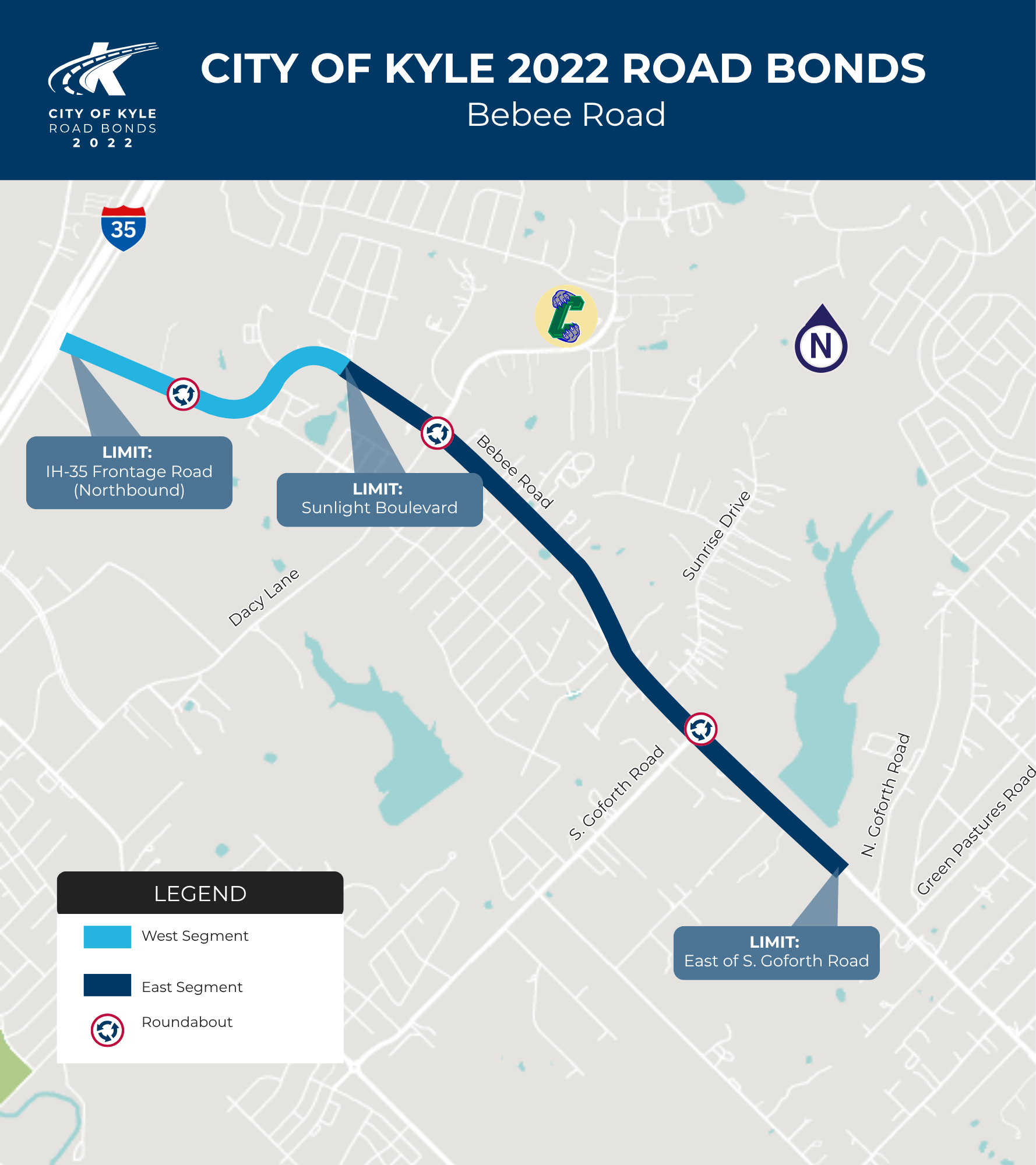

West Segment Limits: From IH 35 Northbound Frontage Road to Sunlight Boulevard

East Segment Limits: From Sunlight Boulevard to east of S Goforth Road

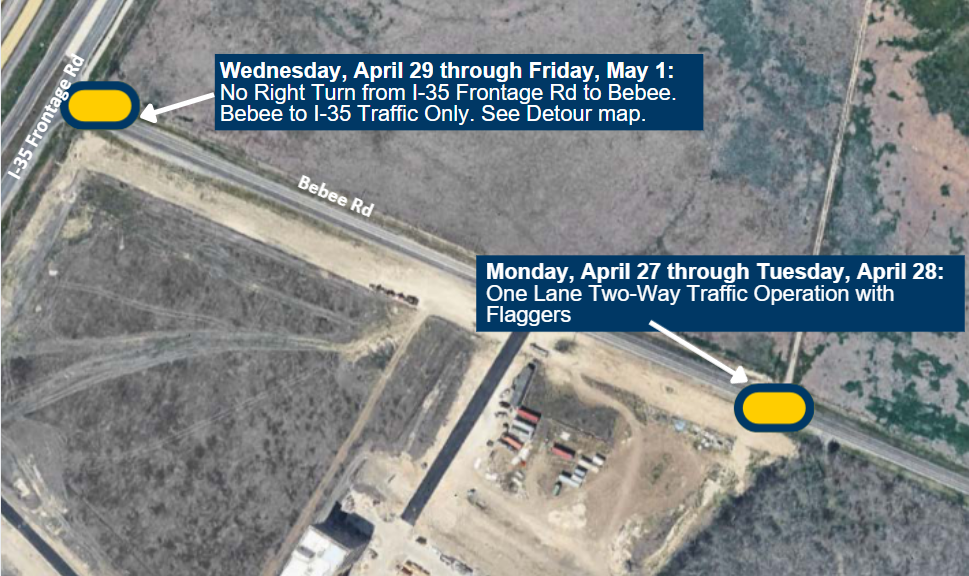

Bebee Road Closure

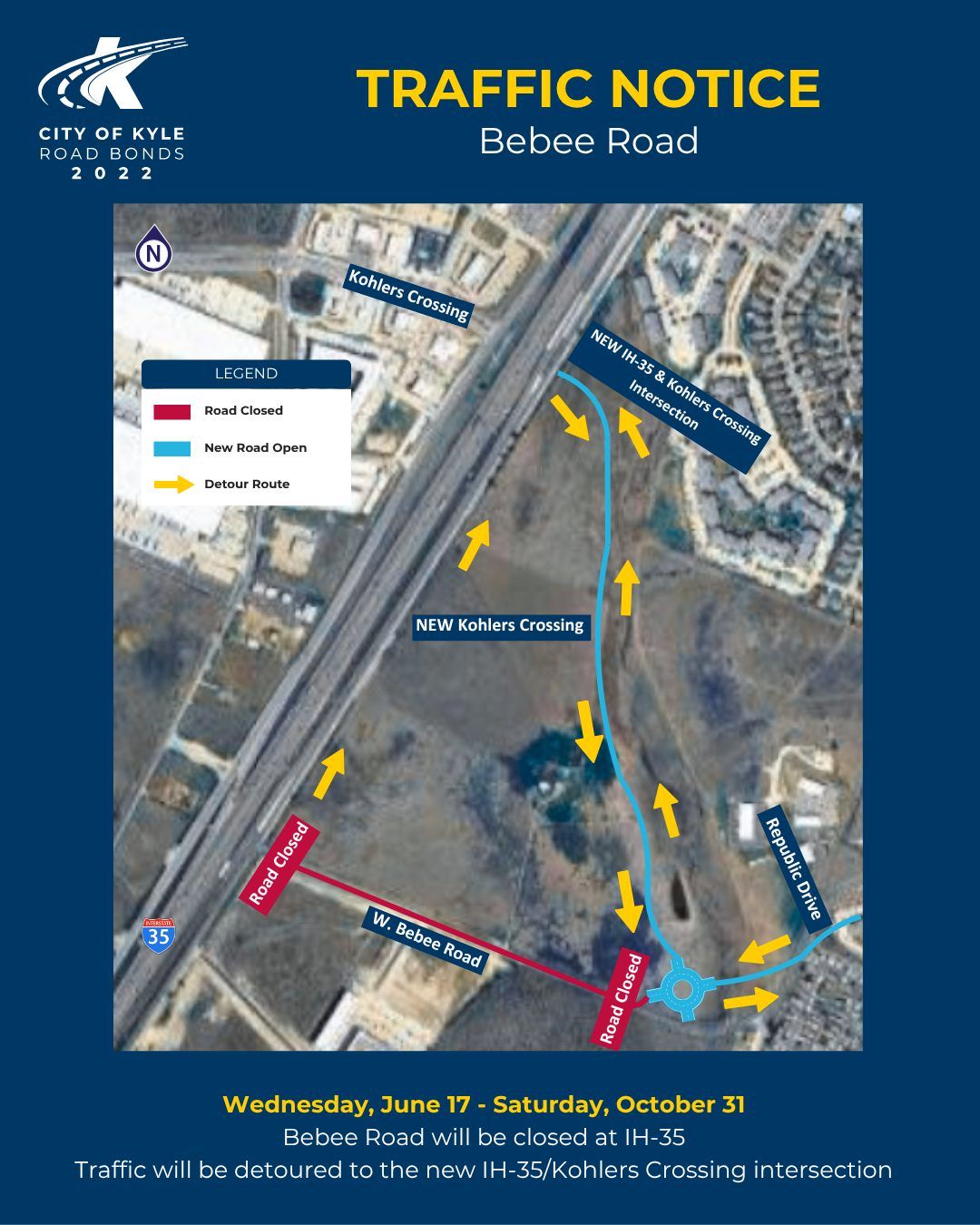

Beginning Wednesday, June 17, and continuing through Saturday, October 31, Bebee Road will be temporarily closed at IH-35 as part of the 2022 Road Bond Program construction project.

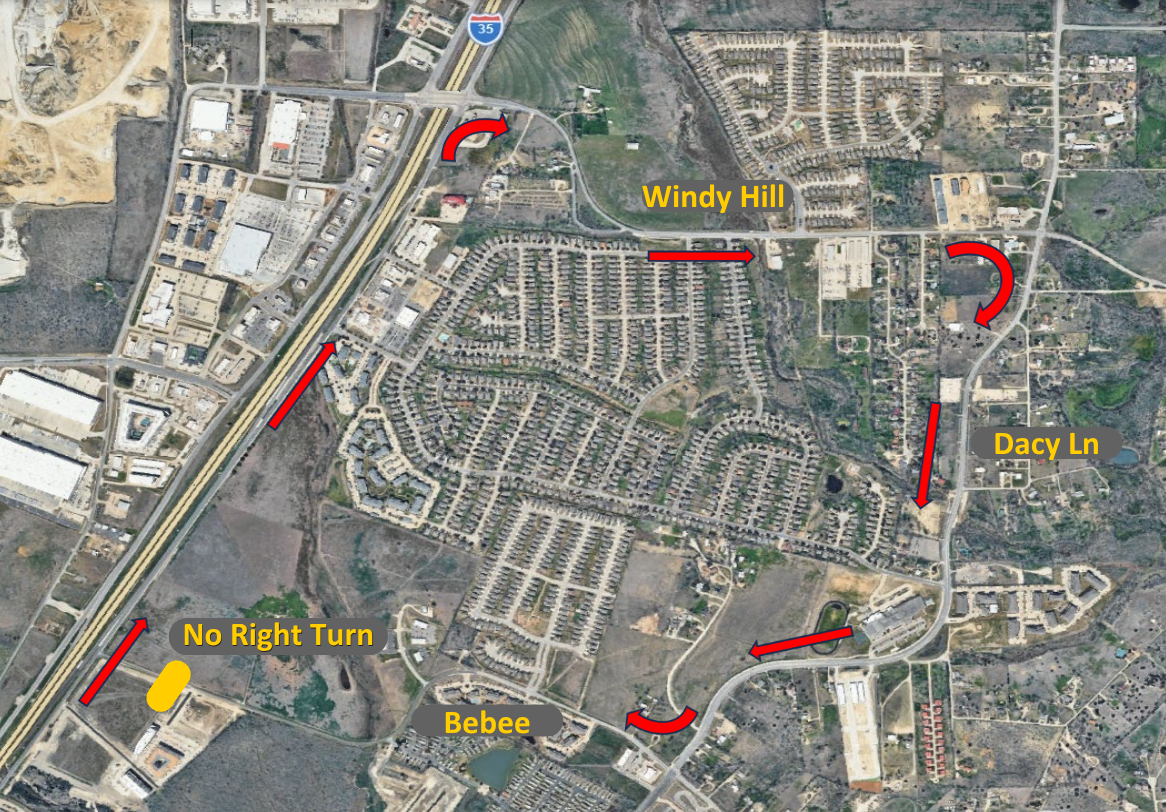

During the closure, traffic will be detoured through the new IH-35/Kohlers Crossing intersection and along the Kohlers Crossing extension, reconnecting with Bebee Road west of Republic Drive. One lane in each direction will remain open to accommodate through traffic.

Access to Lakeside Crossing from Bebee Road will remain open during this phase of construction.

The work being done on Bebee Road includes widening it from two lanes to four with a center turn lane, the addition of drainage, curbs, and sidewalks along both sides.

Motorists may experience delays and are encouraged to use alternate routes when possible. Please follow all posted traffic control devices, watch for construction crews and equipment, and use extra caution when traveling through the work zone.

Project Updates

Summer 2026

Bebee Road (West) – Construction

Construction continues along the future Bebee Road alignment between Republic Drive and Dacy Lane, with work focused on roadway, utility, and drainage improvements within the corridor. Ongoing activities include waterline installation toward Bunton Branch Creek, Astound conduit installation between IH-35 and the roundabout, utility coordination, and continued roadway preparation. The Kohlers-to-Bebee connection remains open as part of the temporary detour route to maintain traffic through the construction area.

Upcoming work includes storm sewer installation and utility reconstruction along Bebee Road, drainage stabilization, and continued roadway improvements supporting the future connection between Bebee Road and the Kohlers corridor.

Bebee Road (East) – Final Design

The design is 95% complete. The tie-in location has been finalized, and an updated schedule for the final construction documents (the 100% PS&E package) is expected soon.

Overview

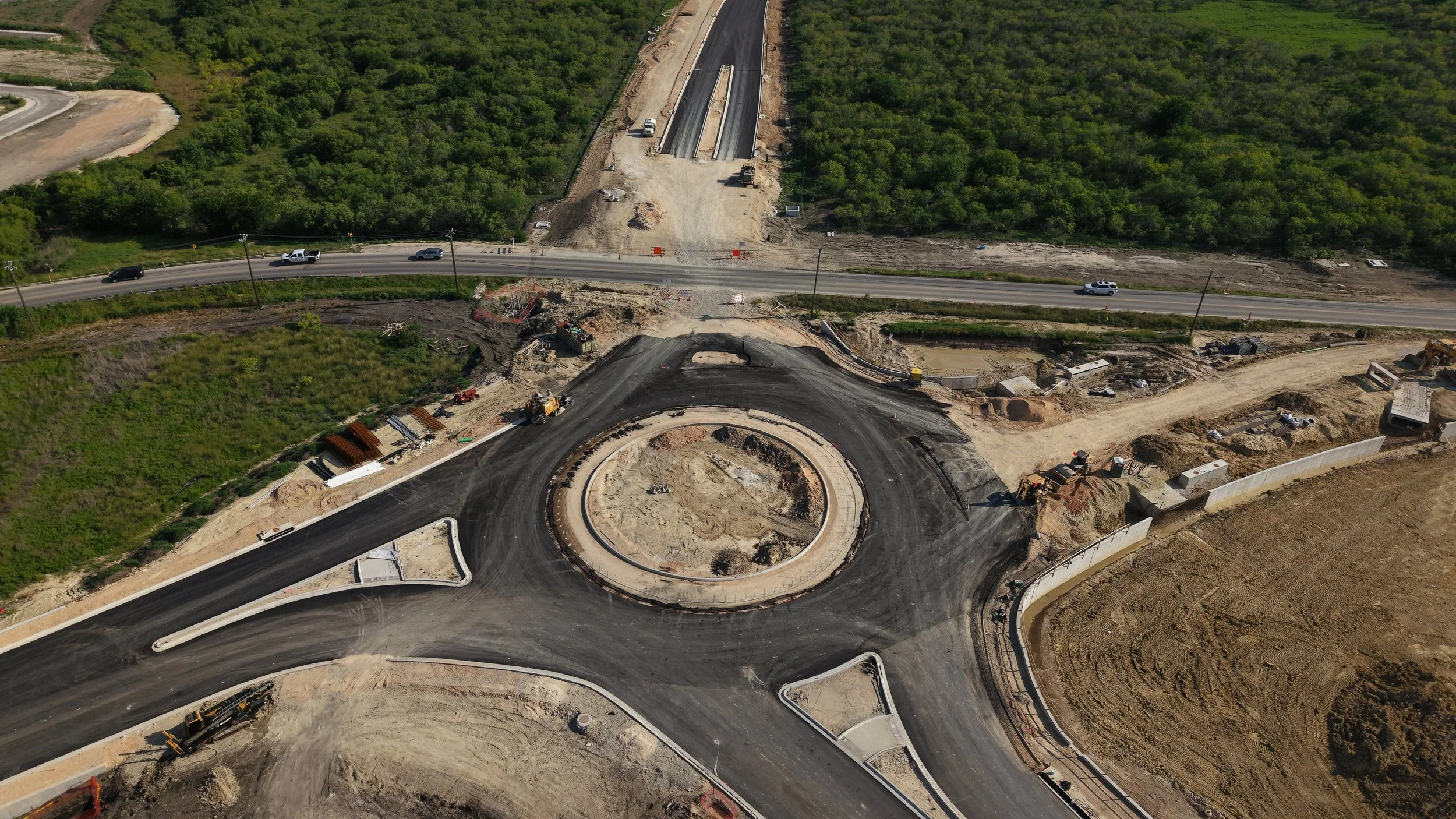

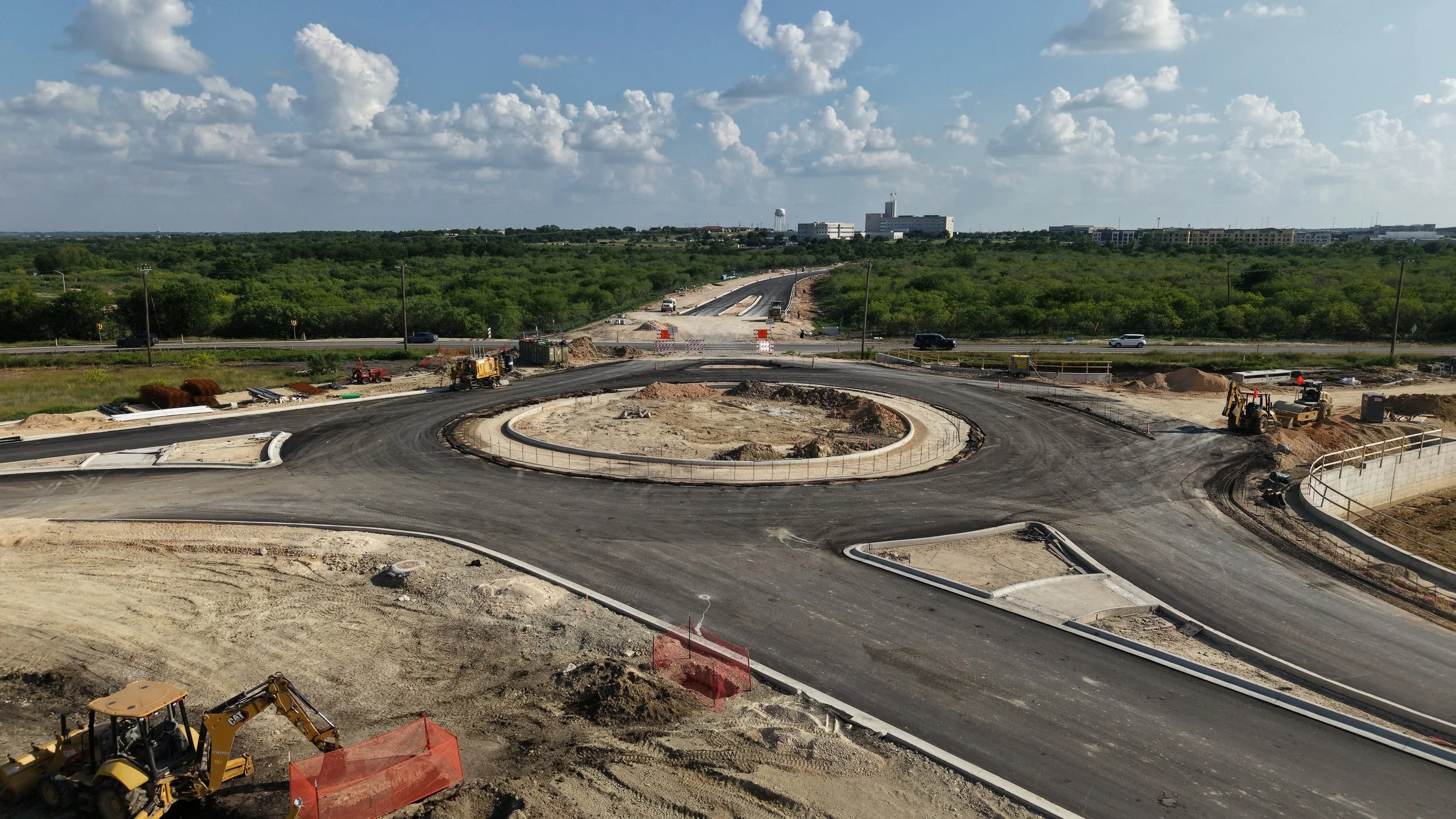

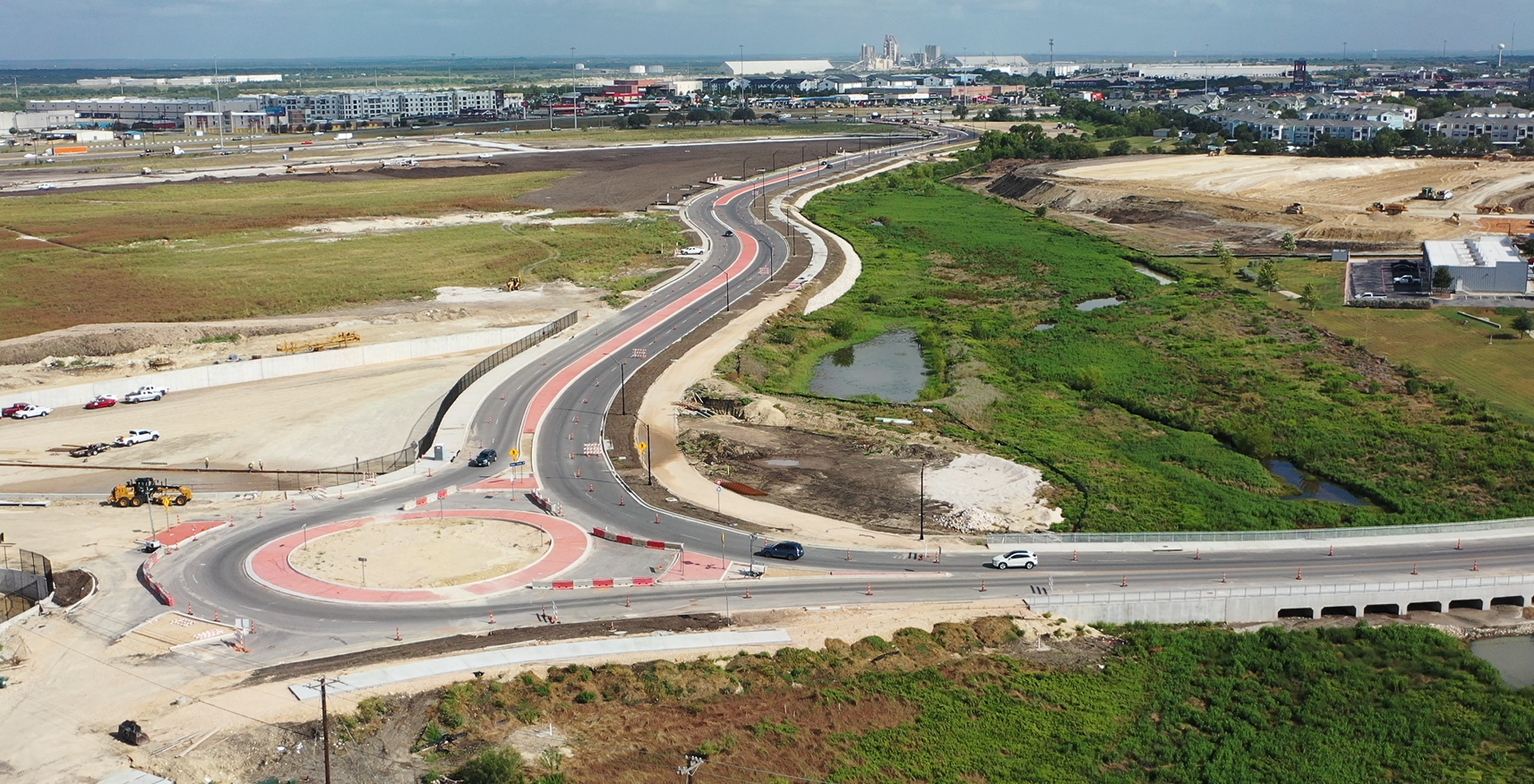

West segment: Under construction, this project will realign the sharp curves and add capacity to a 1-mile stretch of Bebee Road between northbound frontage road of IH 35 and Sunlight Boulevard with a roundabout at the intersection of the new Kohlers Crossing and Bebee Road.

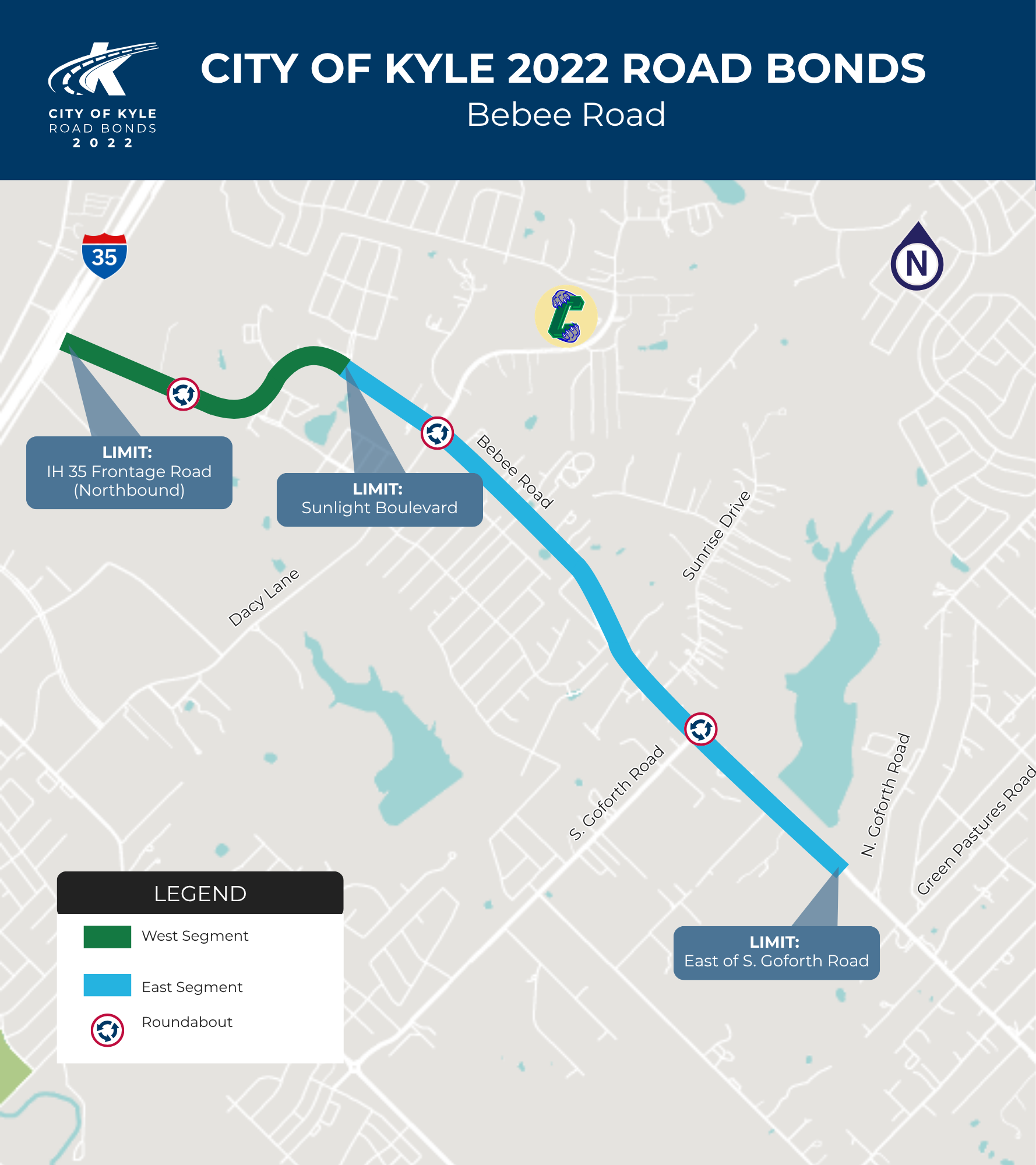

East segment: Approximately 2 miles of a new four-lane minor arterial roadway will be constructed from Sunlight Boulevard to east of S. Goforth Road, along with new roundabouts at the intersection of Bebee Road & Dacy Lane.

2022 Road Bond Update

Per City Council direction on July 7, 2026, we are conducting updated traffic studies to reevaluate intersections throughout the City of Kyle. A recommendation will be provided once updated data has been collected and analyzed. Pedestrian facility is also being evaluated. Due to these ongoing evaluations, current plans are subject to change.

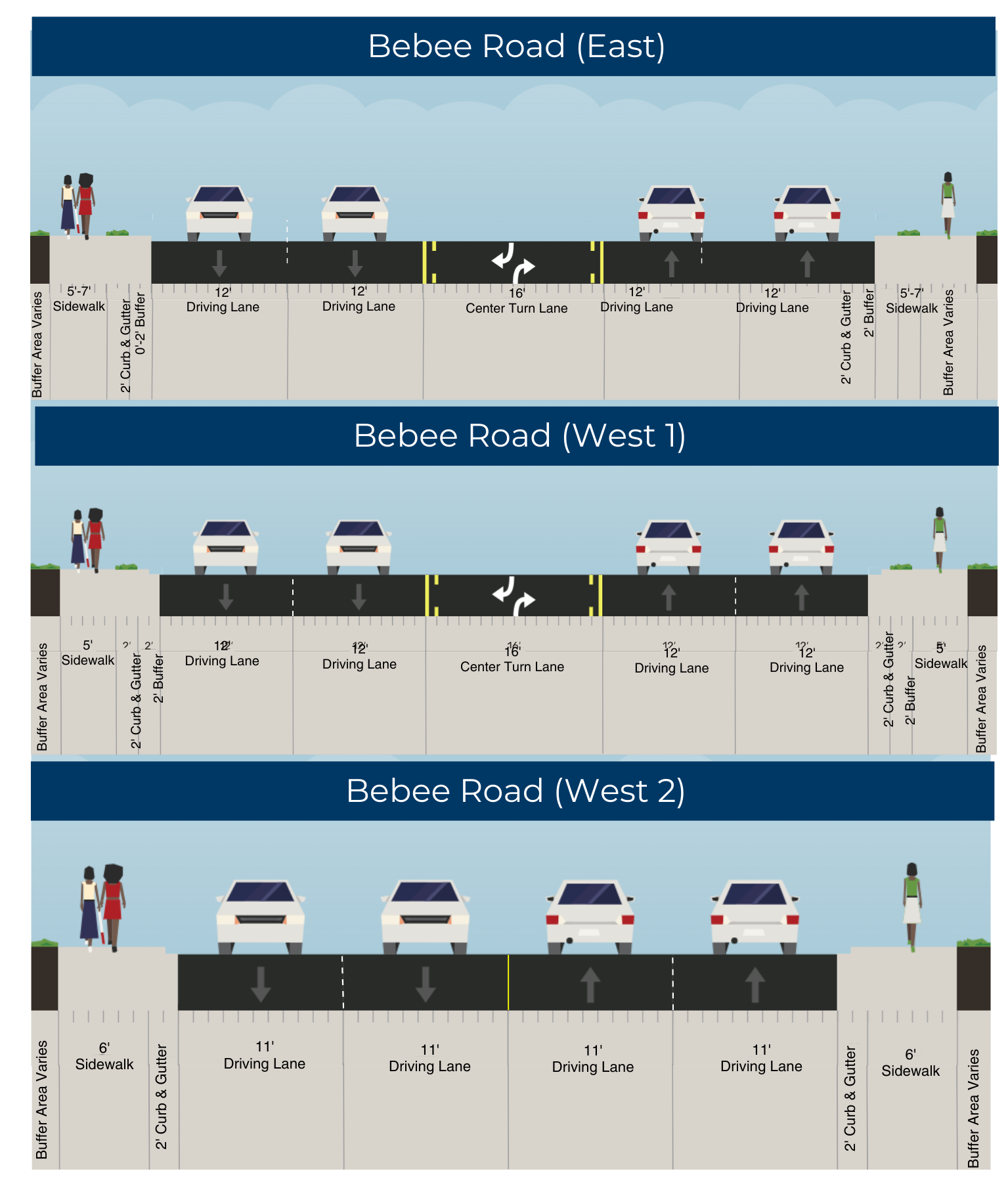

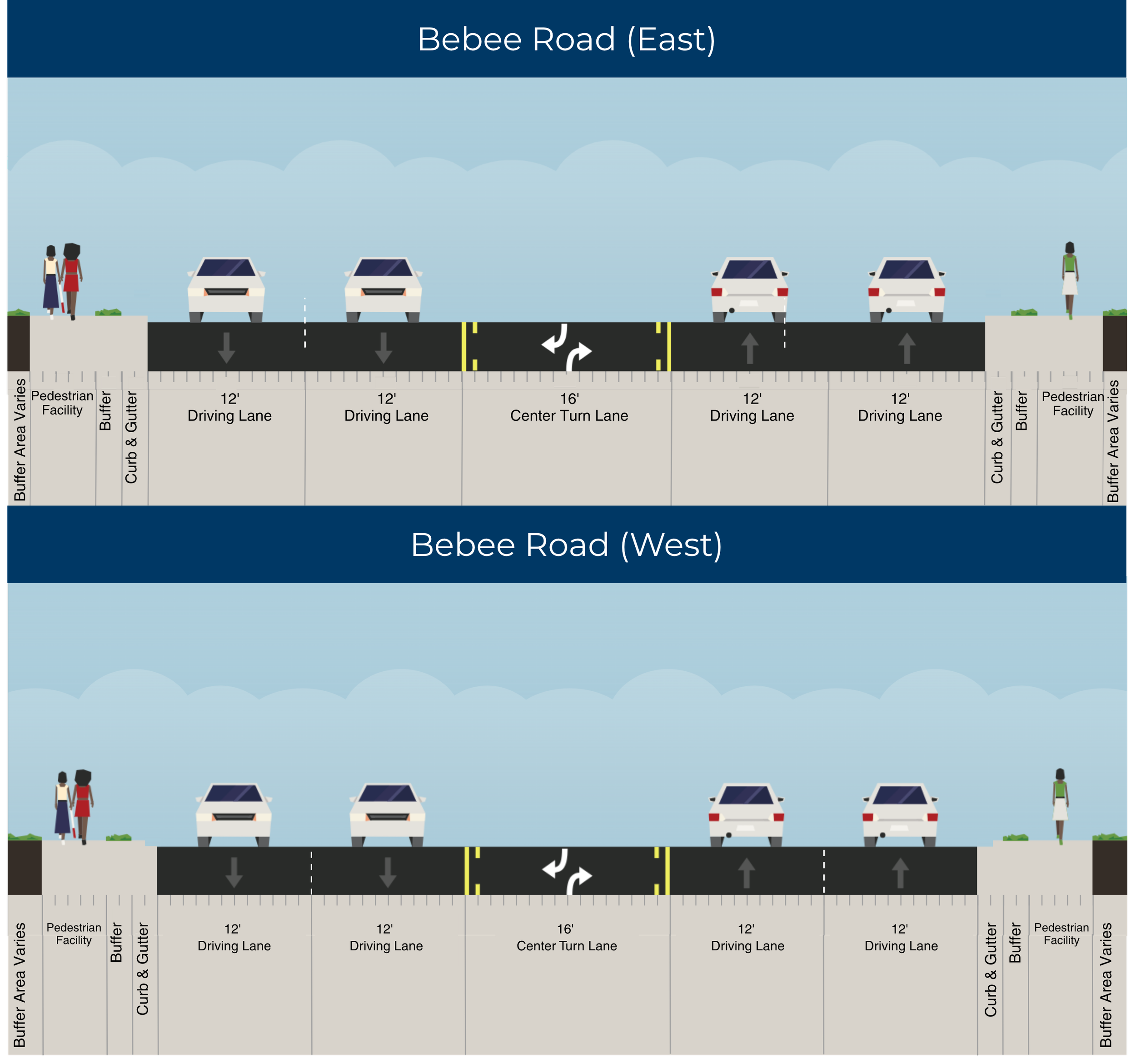

Road Design Cross Section

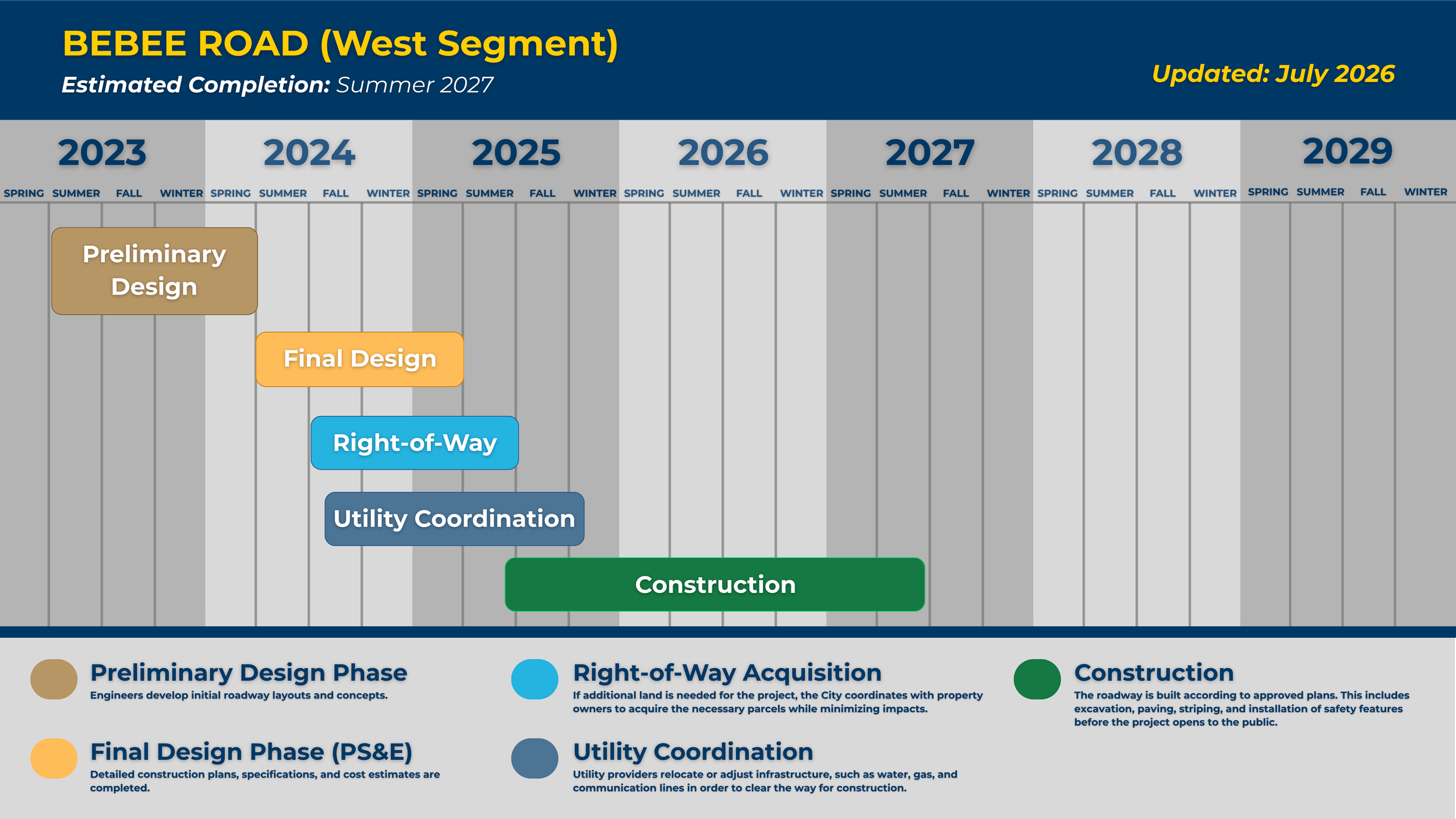

Schedule and Project Status

Project Resources

Navigating Construction Near Your Home or Business?

Review our Construction Survival Guide for how to stay up-to-date and informed.

Groundbreaking Event

On July 17, 2025 the City of Kyle celebrated an exciting milestone — breaking ground on two major road projects from the 2022 Road Bond Program. Work is officially underway on the widening of Bebee Road and the extension of Kohlers Crossing to Seton Parkway, both designed to improve safety, connectivity, and traffic flow for our growing community.

Frequently Asked Questions

In accordance with Title VI of the Civil Rights Act of 1964 and related statutes, it is the policy of the City of Kyle to ensure that no person shall be excluded from participation in, denied the benefits of, or otherwise subjected to discrimination under any programs or activities on the grounds of race, color, national origin, sex, age, or disability.
