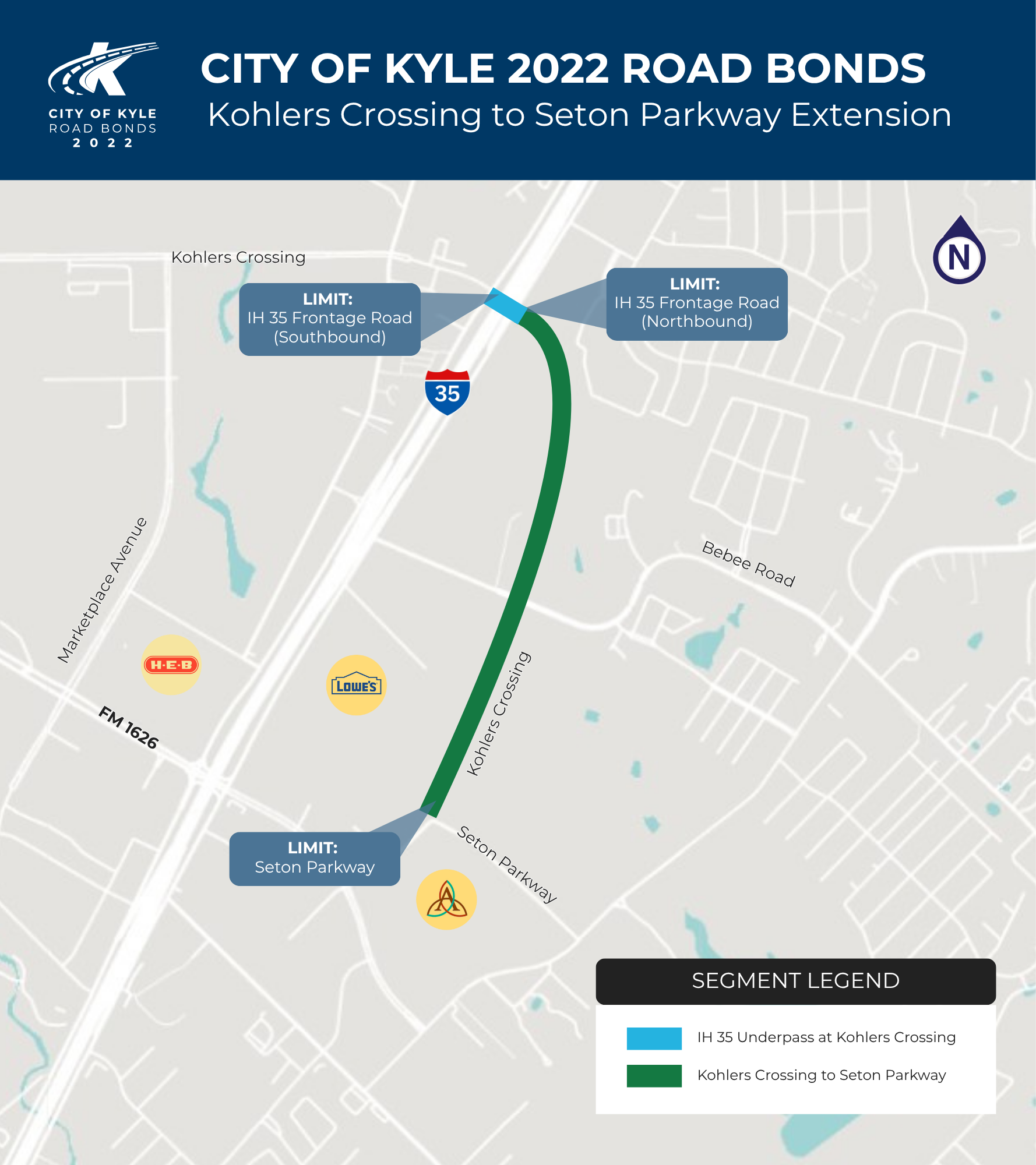

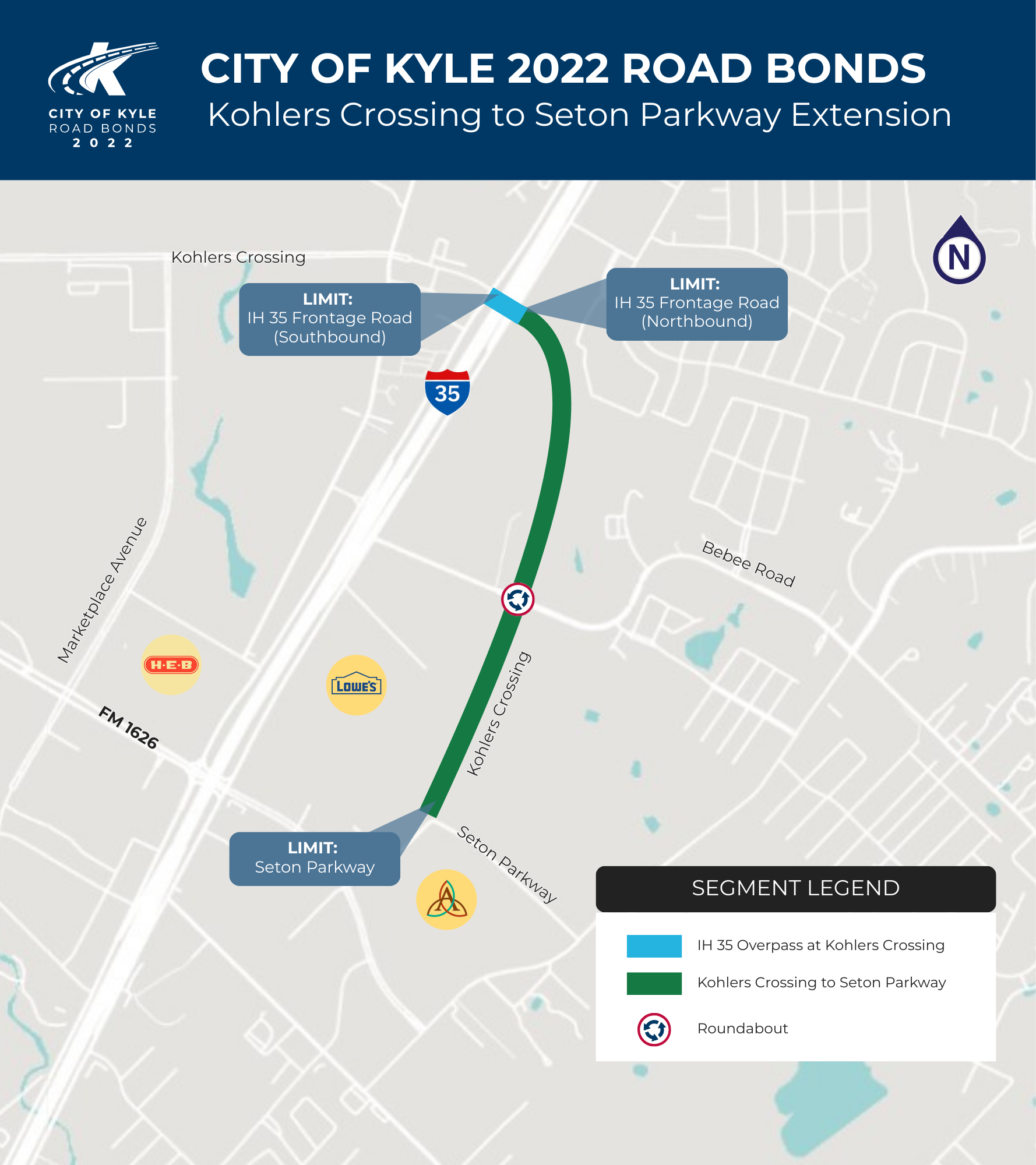

KOHLERS TO SETON

Segment 1: IH 35 northbound frontage road to Seton Parkway (currently under construction)

Segment 2: IH 35 improvements that are part of the Texas Department of Transportation (TxDOT) system

Overview

This project will extend Kohlers Crossing to connect with Seton Parkway, creating a new five lane underpass beneath I-35. The new roadway segment will continue as Kohlers Crossing. The work will be completed in two segments:

Main segment (under construction): Extends the road from IH 35 northbound frontage road to Seton Parkway.

IH 35 Improvements (on TxDOT system): Construction of an overpass to create space for the new Kohlers Crossing connection.

Project Updates

March 2026

Kohlers to Seton - Construction

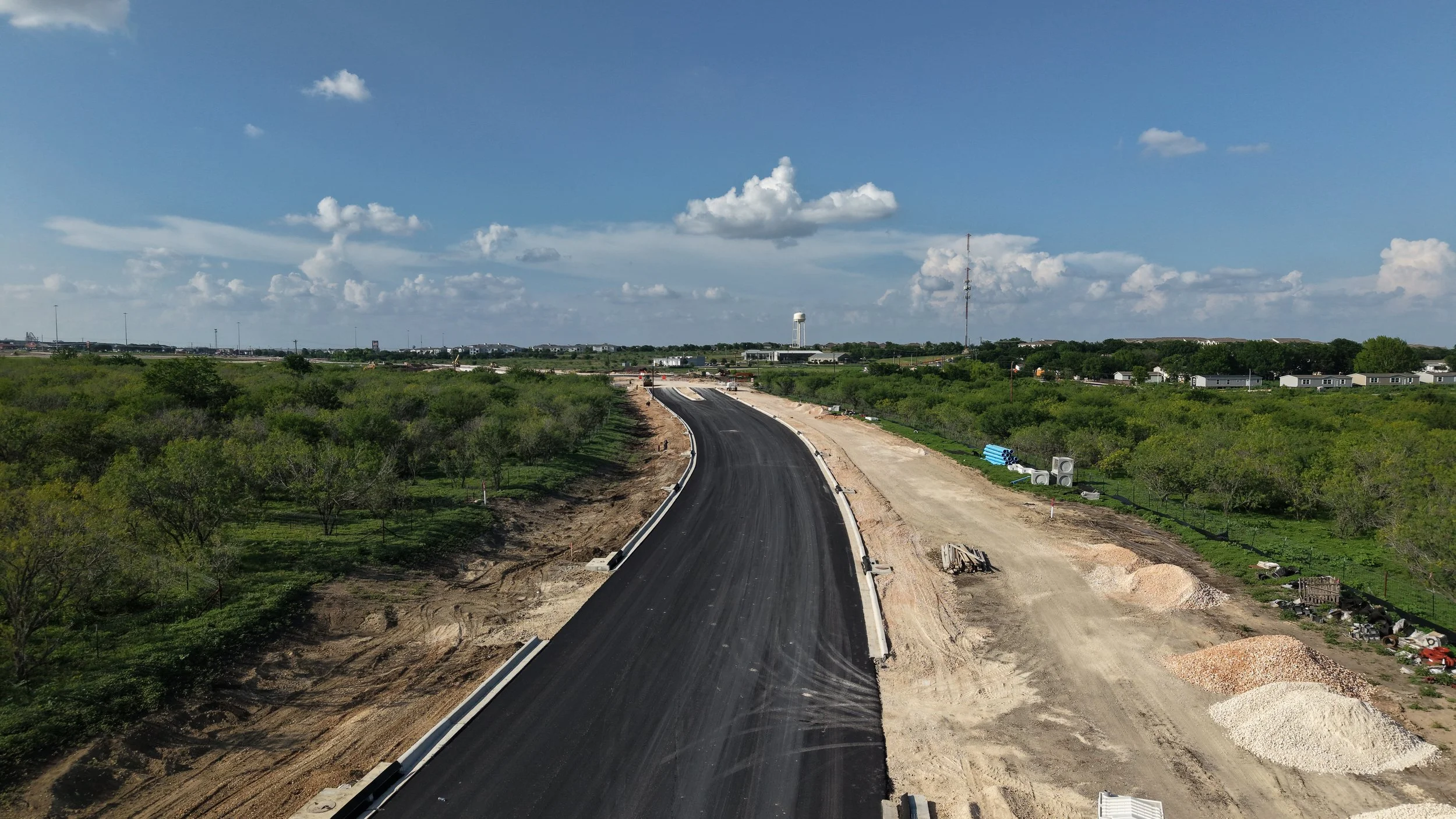

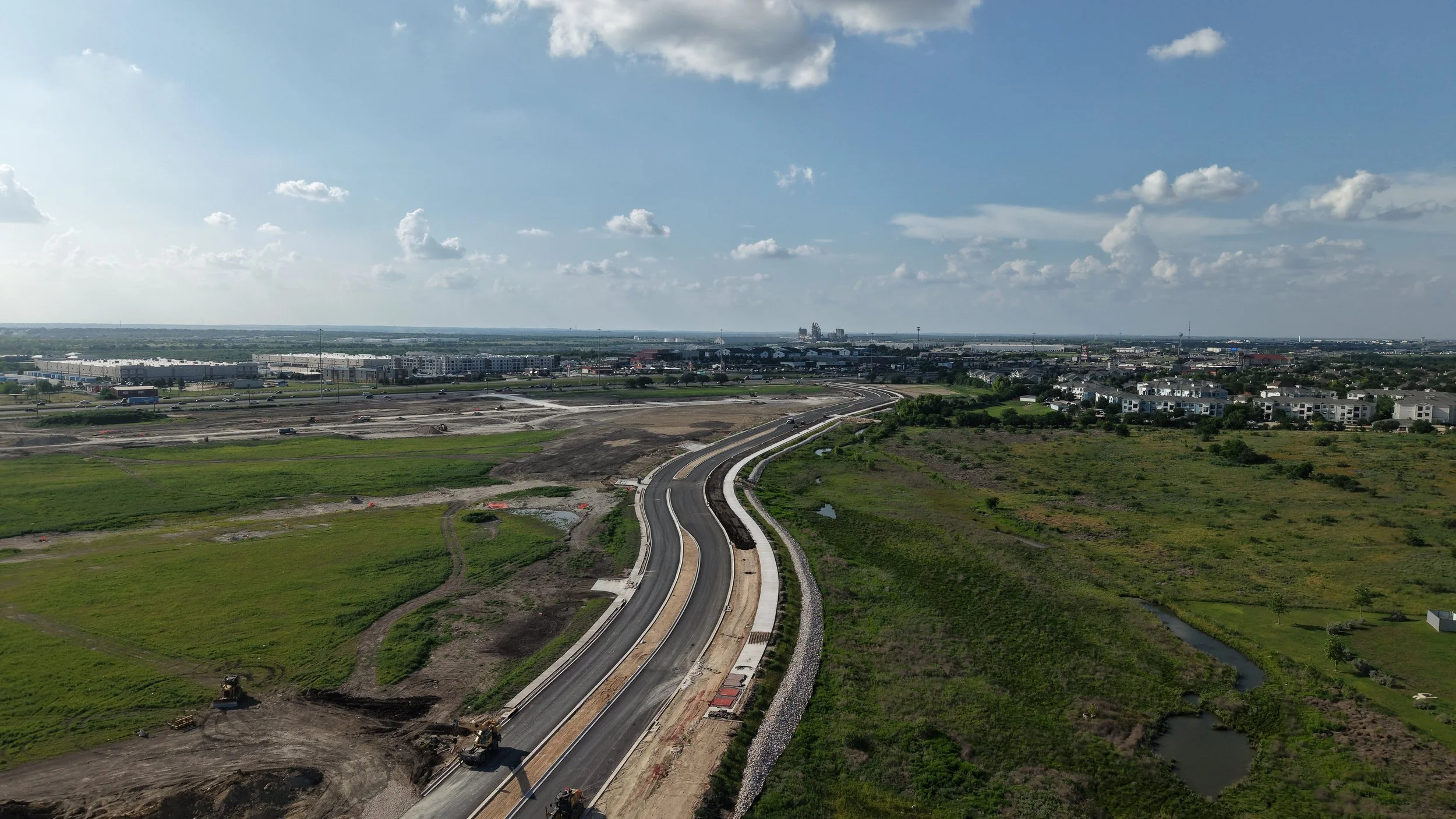

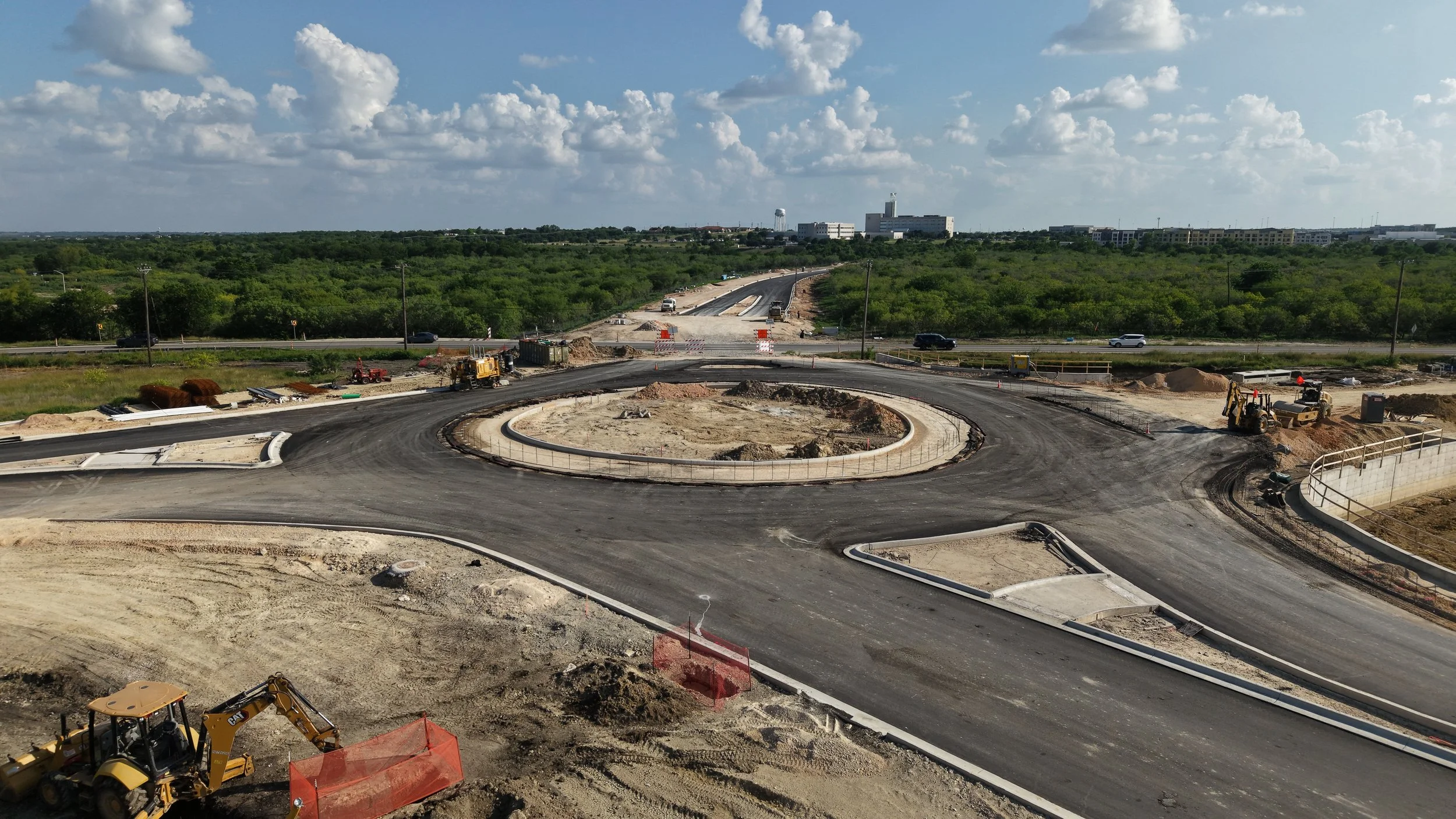

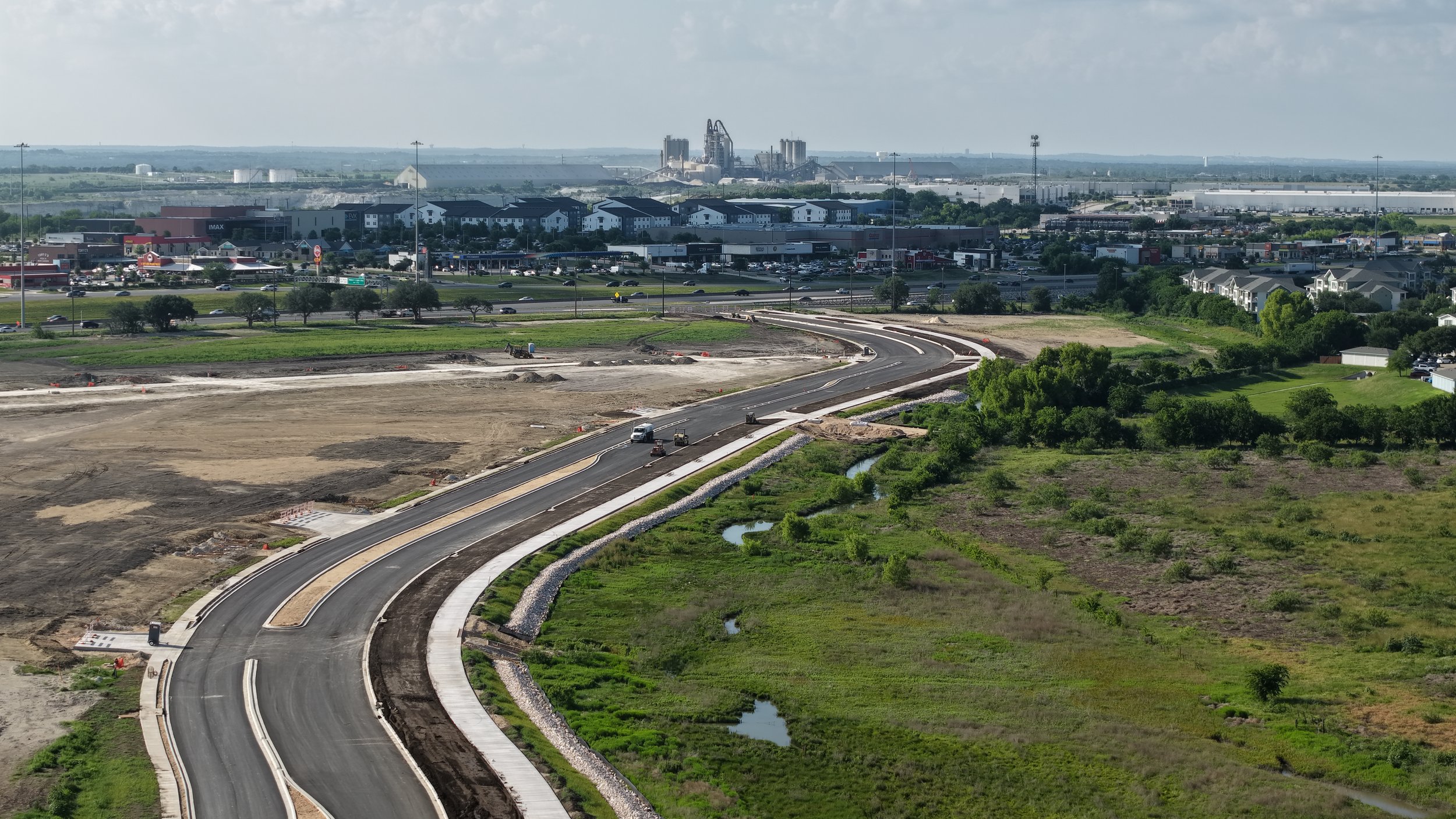

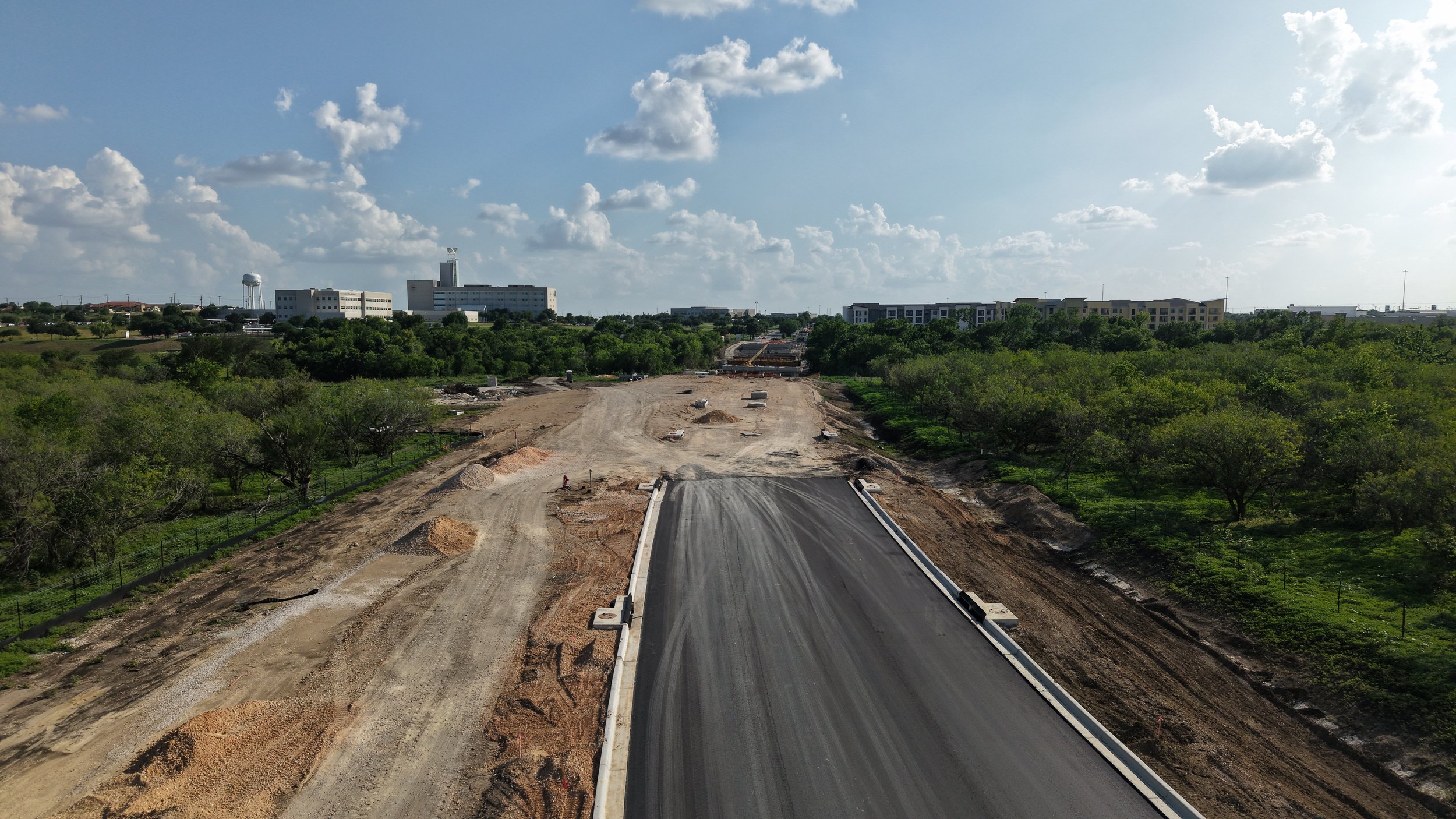

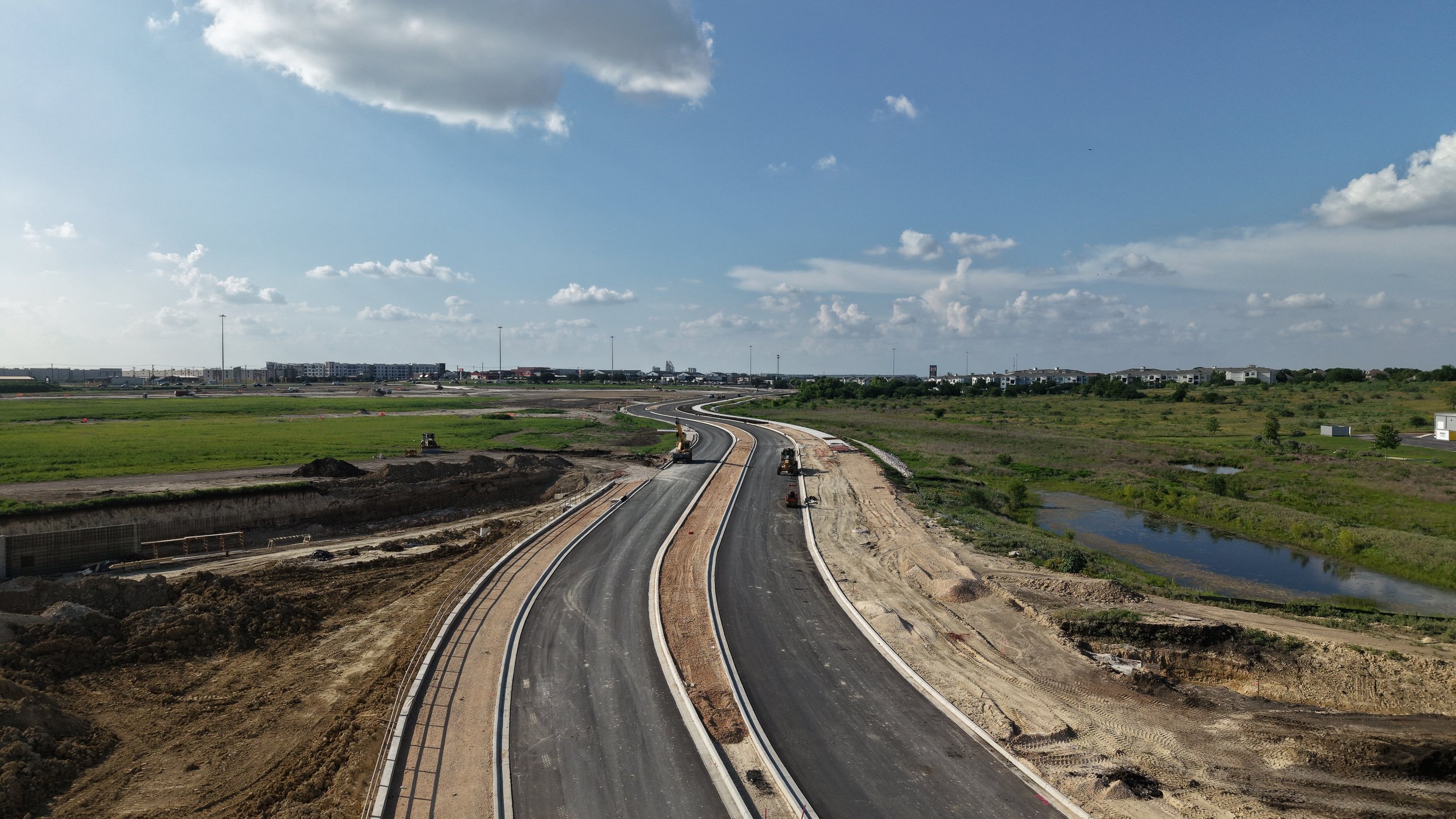

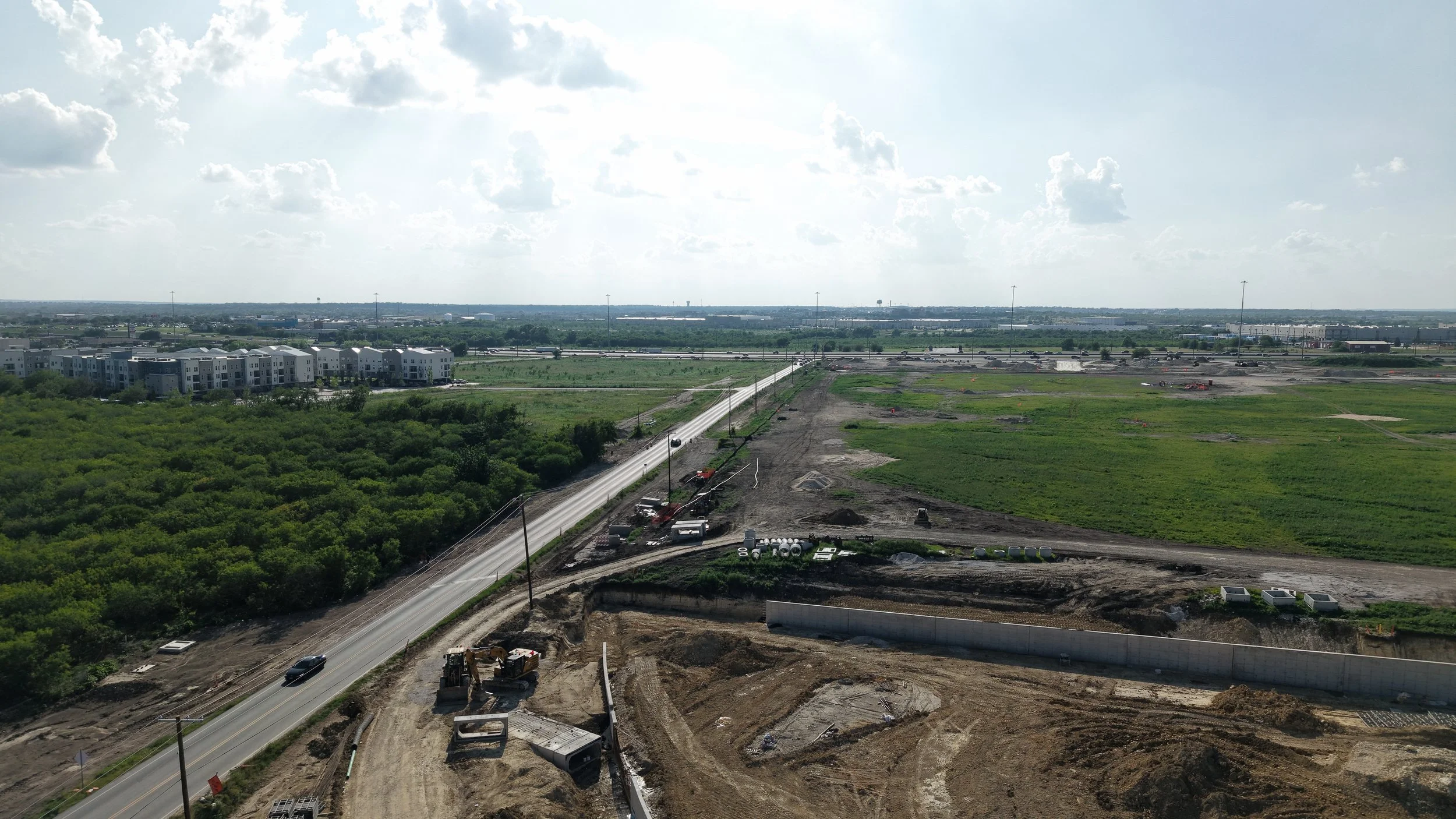

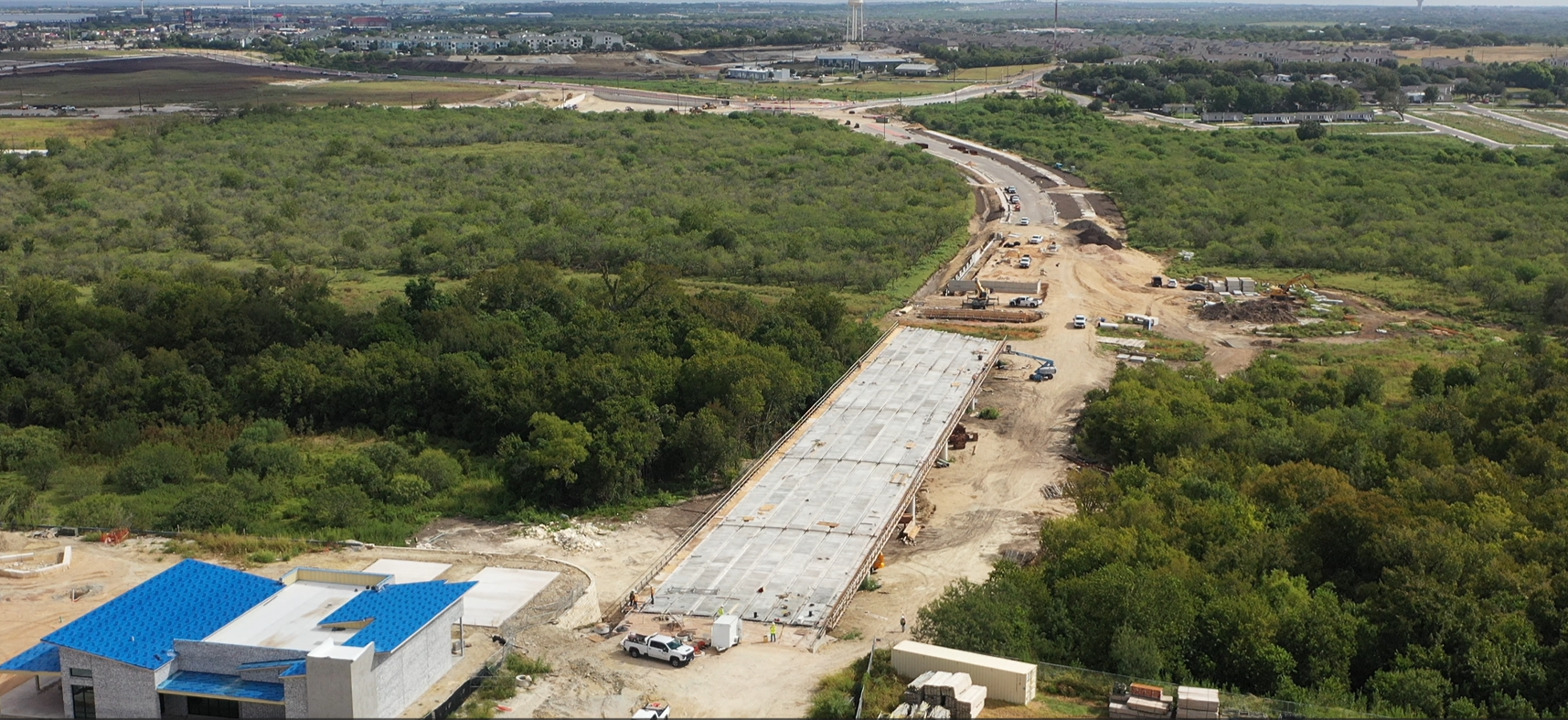

Construction is moving forward along the Kohlers to Seton corridor. Work is currently happening in several areas, including near Bebee Road (West). Along the future Bebee Road connection between Republic Drive and the planned Kohlers Crossing/Bebee Road roundabout, crews are building up the roadway base and installing storm drainage pipes. Additional roadway preparation is taking place near the future Vybe Trail. Utility companies are also relocating lines in the area to clear the way for upcoming road and bridge construction.

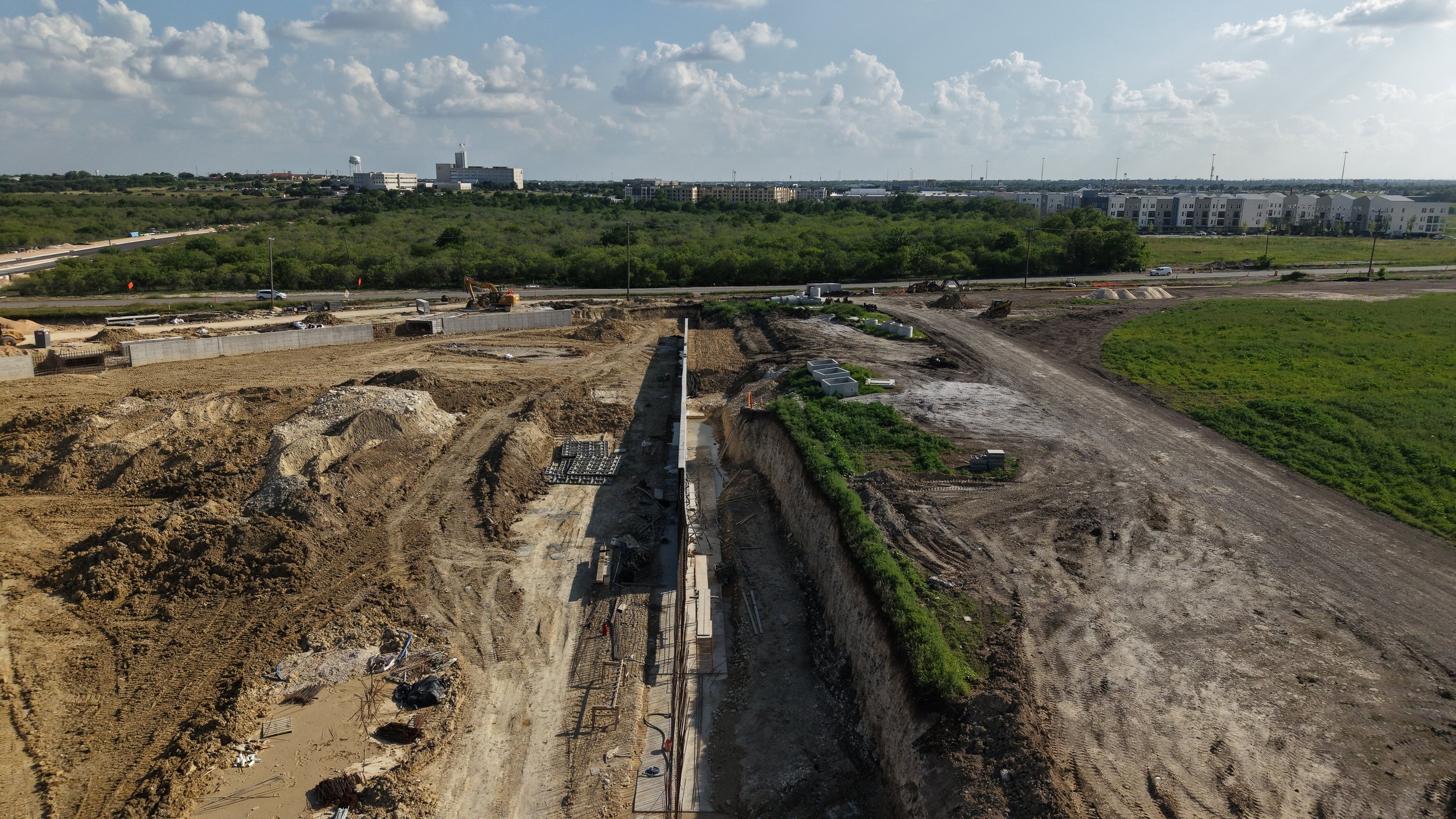

Stormwater improvements are progressing as well. Crews are excavating and building retaining walls for a new stormwater detention pond, installing drainage systems, and constructing sidewalk, curb, and gutter along the IH-35 frontage road.

Kohlers to Seton (IH 35 at Kohlers Crossing)- Early-Stage Design

Early design plans for the project are about 60% complete. At the end of February, the team submitted an updated intersection study and revised design plans to the Texas Department of Transportation (TxDOT) for review. We anticipate receiving feedback from TxDOT in March and will share updates as they become available.

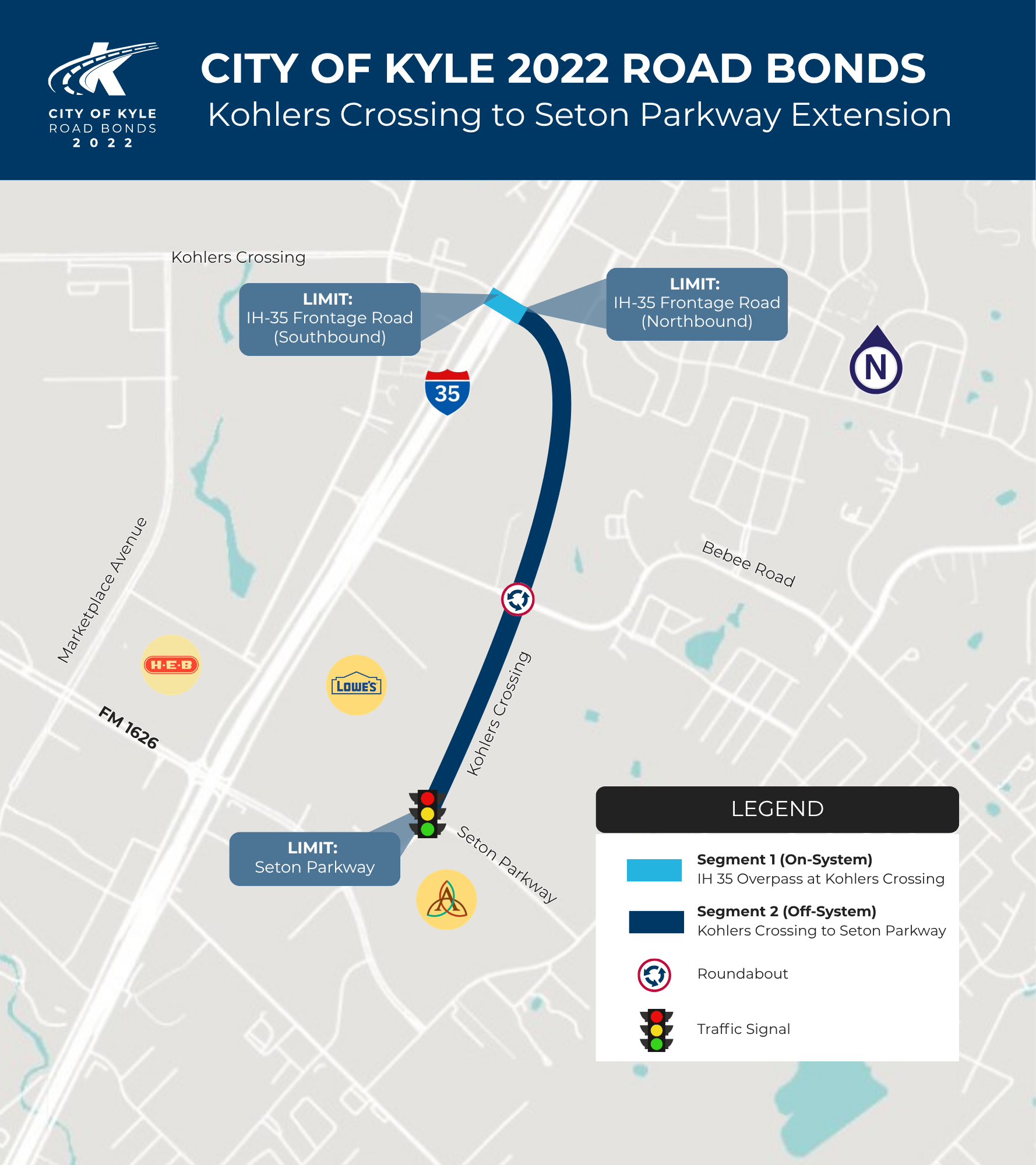

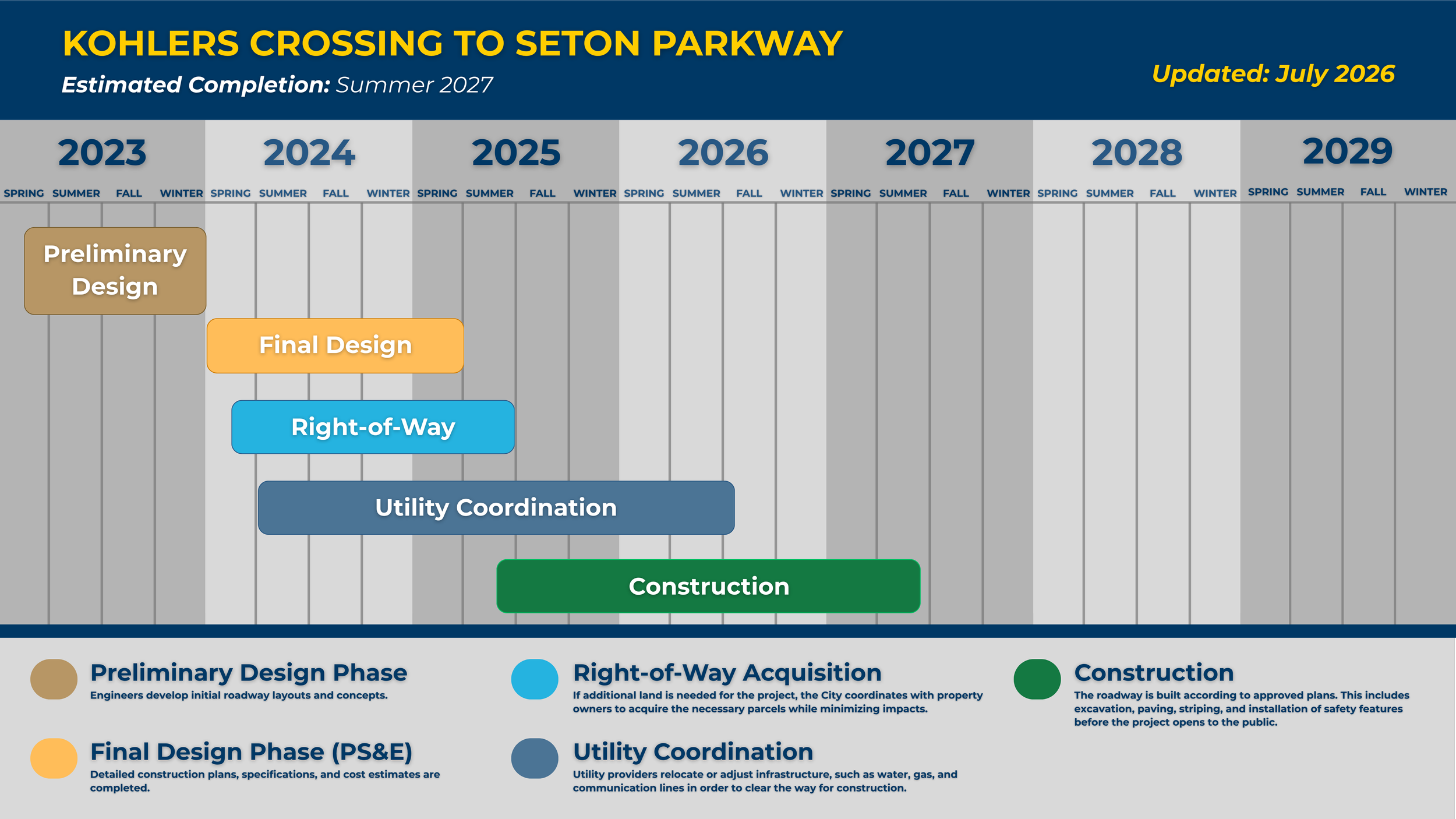

  • Kohlers Crossing to Seton Parkway

    • Length: 1.11 miles

    • Location: Kohlers Crossing at IH 35 Northbound Frontage Road to Seton Parkway

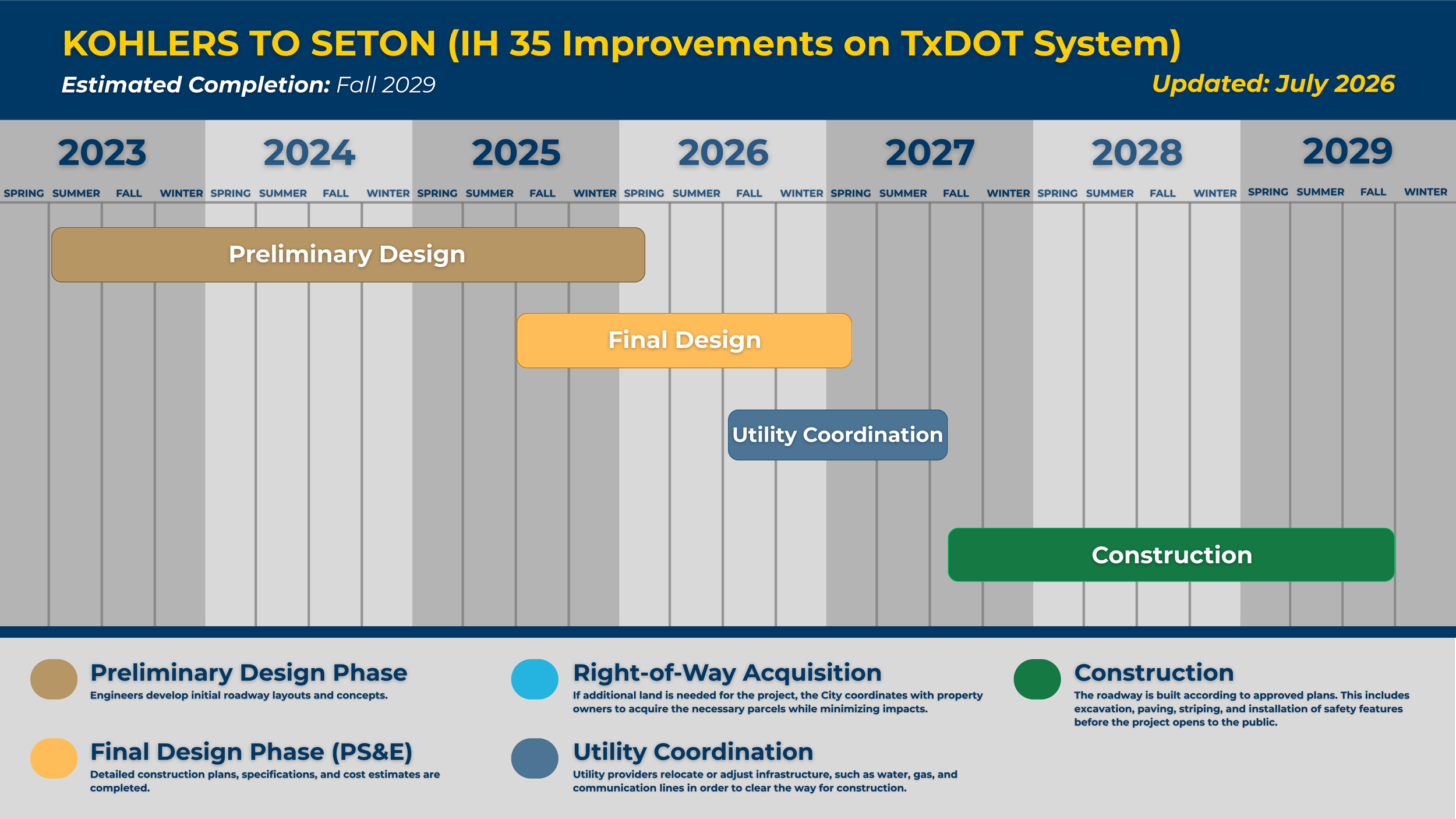

    IH 35 Overpass at Kohlers Crossing

    • Length: 0.13

    • Location: IH 35 Southbound Frontage Road to IH 35 Northbound Frontage Road

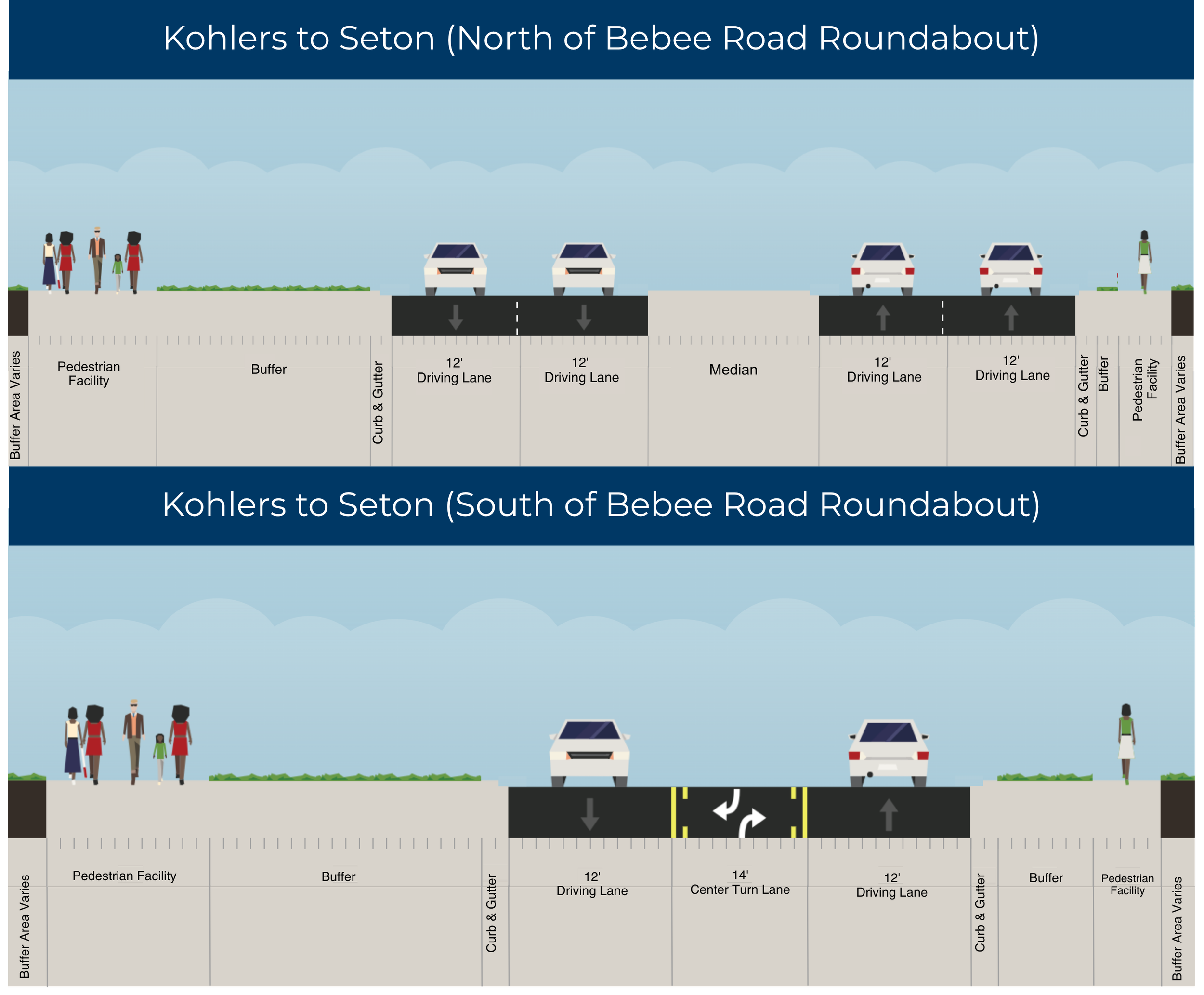

    • Widening of existing roadway to a five-lane underpass at IH 35

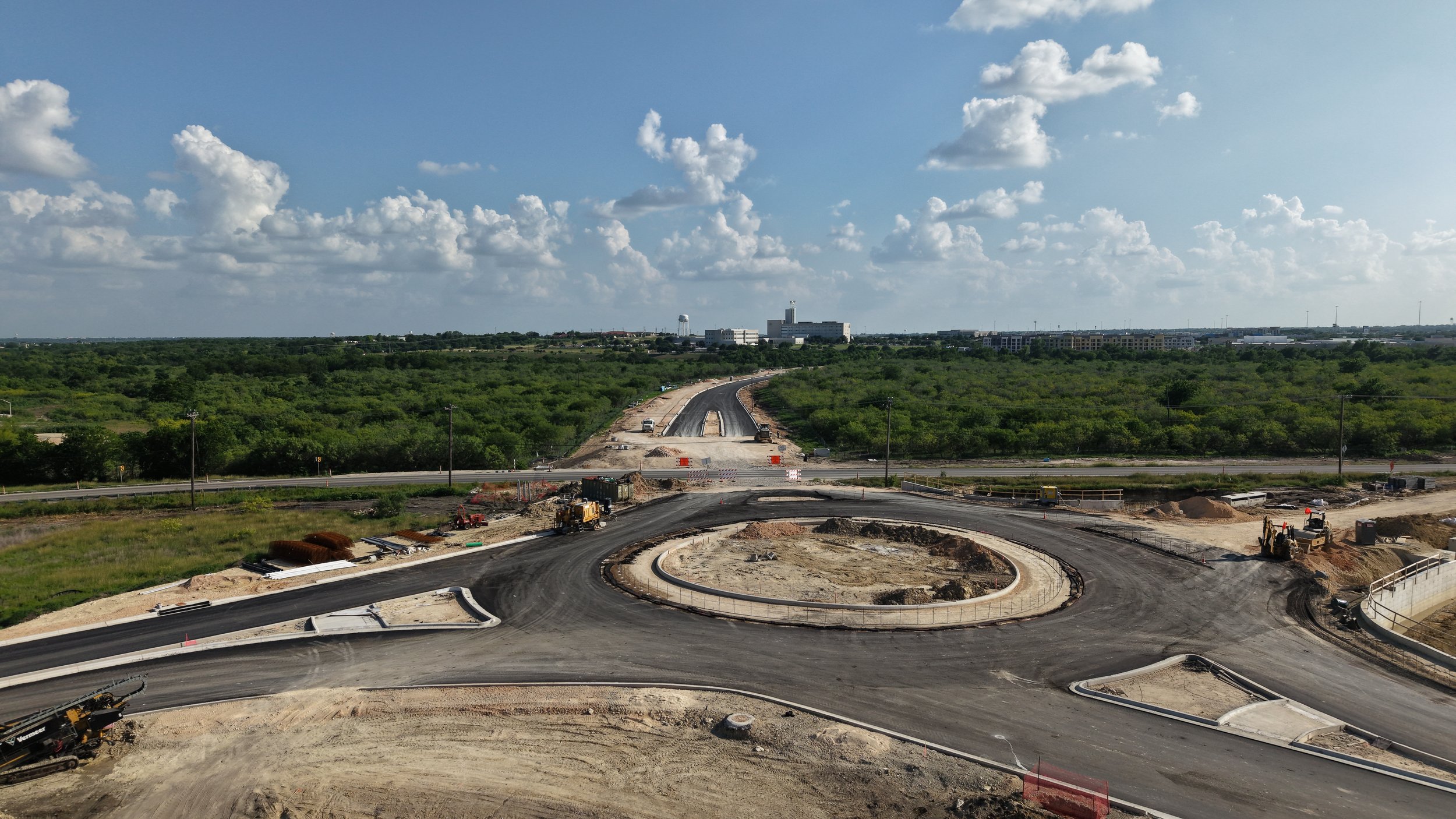

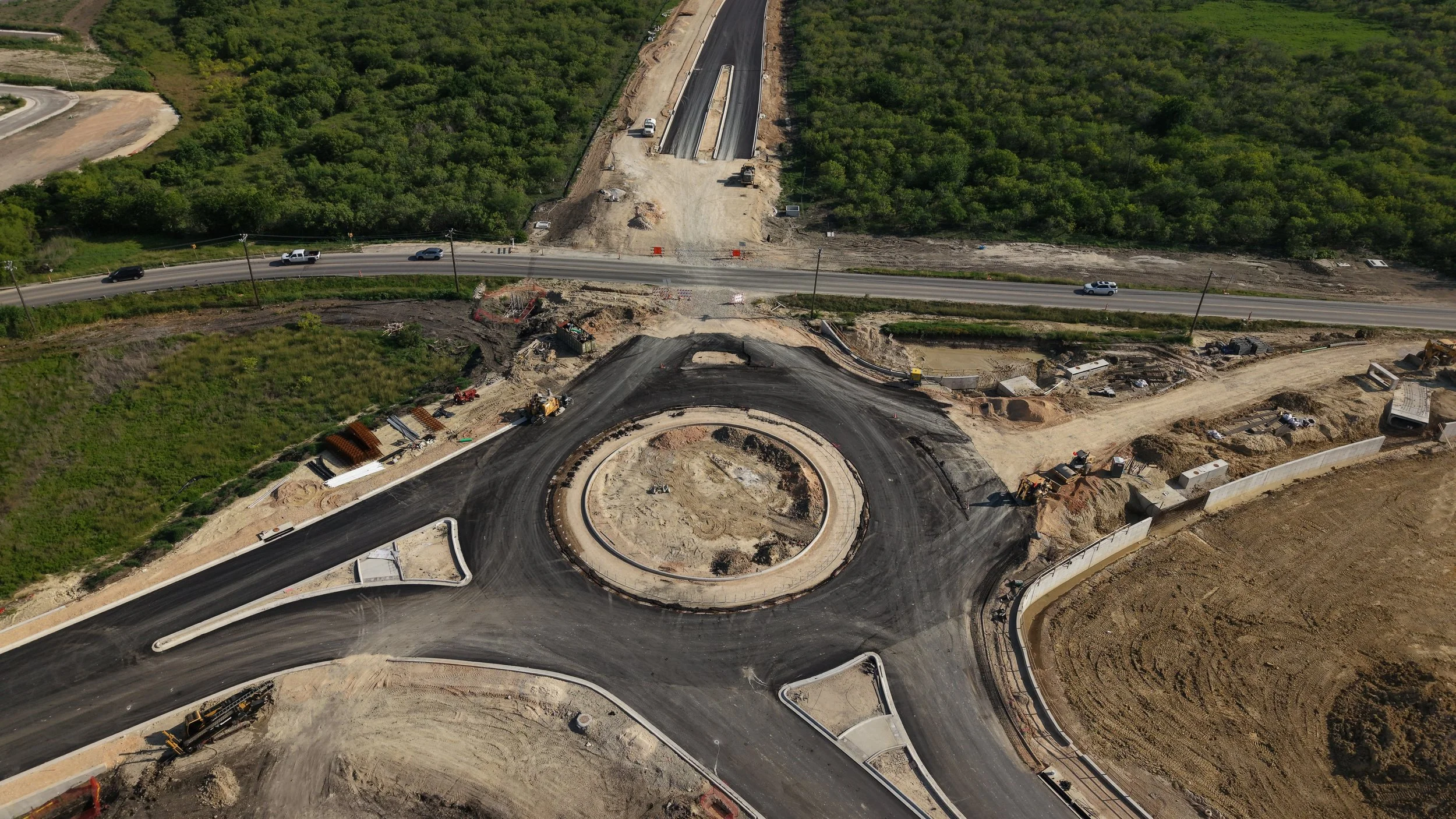

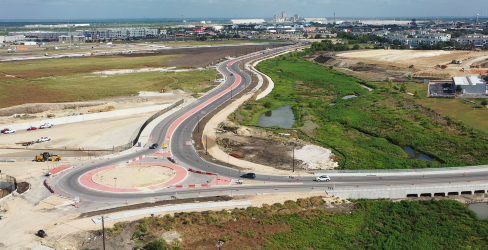

    • Roundabout at the intersection of the new Kohlers extension and Bebee Road

    • Extending Seton parkway to connect with Kohlers Crossing under IH 35, creating a direct route to Seton Hospital

  • Construction funded by the City of Kyle’s 2022 Road Bond

    Total Project Cost = $66.1 M

  • Kohlers Crossing to Seton Parkway

    • Construction began in Summer 2025 and is anticipated to be complete in Summer 2027

    IH 35 Overpass at Kohlers Crossing

    • Construction is anticipated to begin in Fall 2027 and be completed by Fall 2029

Groundbreaking Event

On July 17, 2025 the City of Kyle celebrated an exciting milestone — breaking ground on two major road projects from the 2022 Road Bond Program. Work is officially underway on the widening of Bebee Road and the extension of Kohlers Crossing to Seton Parkway, both designed to improve safety, connectivity, and traffic flow for our growing community.

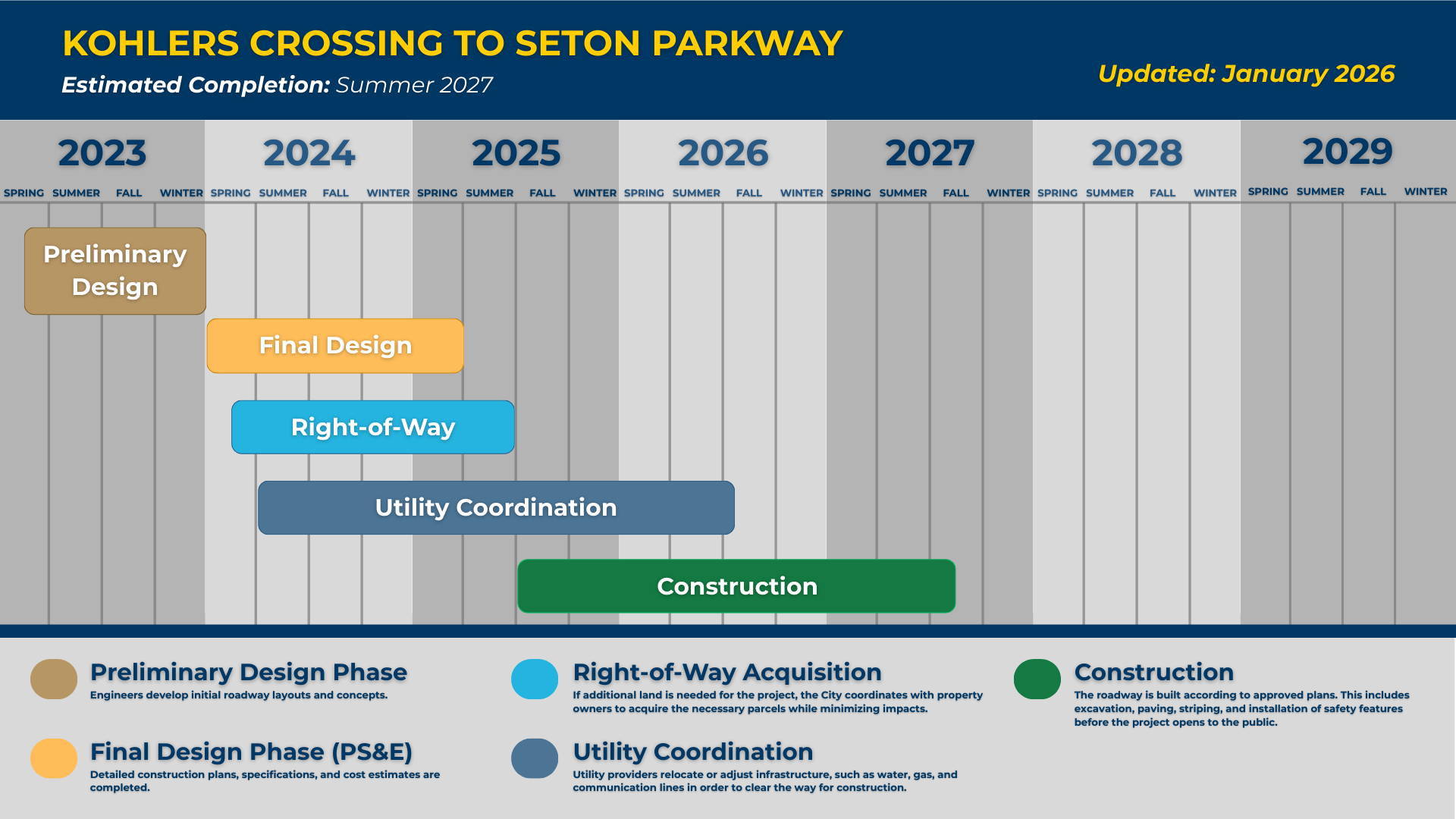

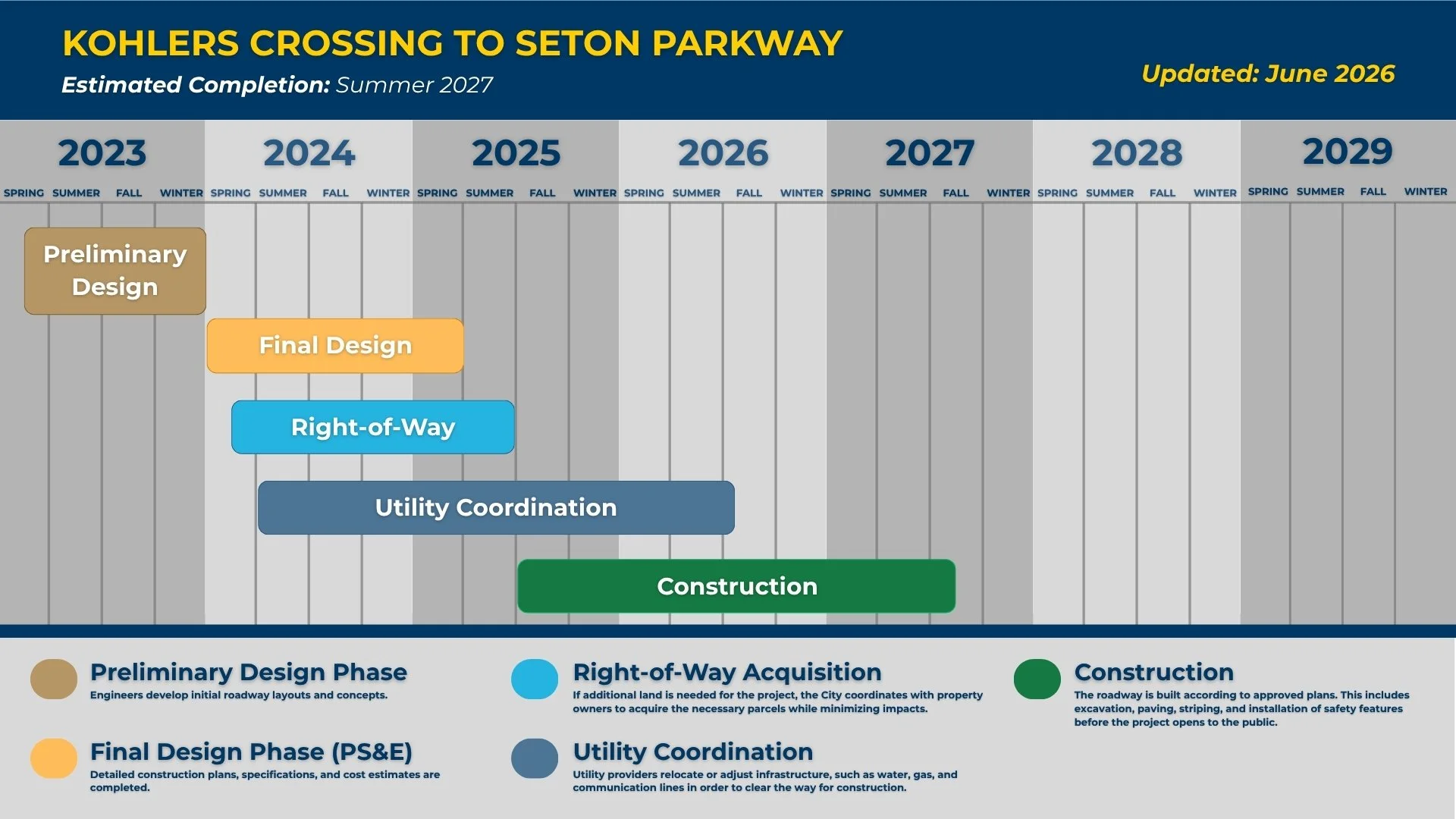

Schedule and Project Status

Project Resources

Previous Project Updates

Two Voter-Approved Road Bond Projects Underway on East of I-35

July 18, 2025

The City of Kyle has broken ground on two major 2022 Road Bond projects east of I-35: the Kohlers Crossing to Seton Parkway extension and the Bebee Road widening. Together totaling over $132 million, these projects will expand road capacity, improve traffic flow, and enhance east-west connectivity to support the city’s rapid growth. They mark the second and third bond projects to begin construction, following Marketplace Avenue earlier this year.

City of Kyle to Break Ground on Two Critical Road Bond Projects East of I-35

July 10, 2025

The City of Kyle will officially break ground on two key roadway projects east of I-35—the extension of Kohlers Crossing to Seton Parkway and the widening of Bebee Road. A groundbreaking ceremony is scheduled for Thursday, July 17 at 9:30 a.m. at 246 Republic Drive. Funded through the voter-approved 2022 Road Bond Program, these projects aim to enhance east-west connectivity, improve traffic flow, and provide better access to Seton Hospital. They represent the second and third projects to begin construction under the bond program, following the Marketplace Avenue extension.

Pre-construction for Bebee and Kohlers to Seton

July 10, 2025

Pre-construction meetings were held on July 9 for both projects, bringing us one step closer to breaking ground. Construction officially kicks off on July 17, with improvements that include wider roadways, turn lanes, and a new roundabout at Bebee Road and Kohlers Crossing to keep traffic moving safely and smoothly.
